Aspirin pilot plant Mechanical Realisation

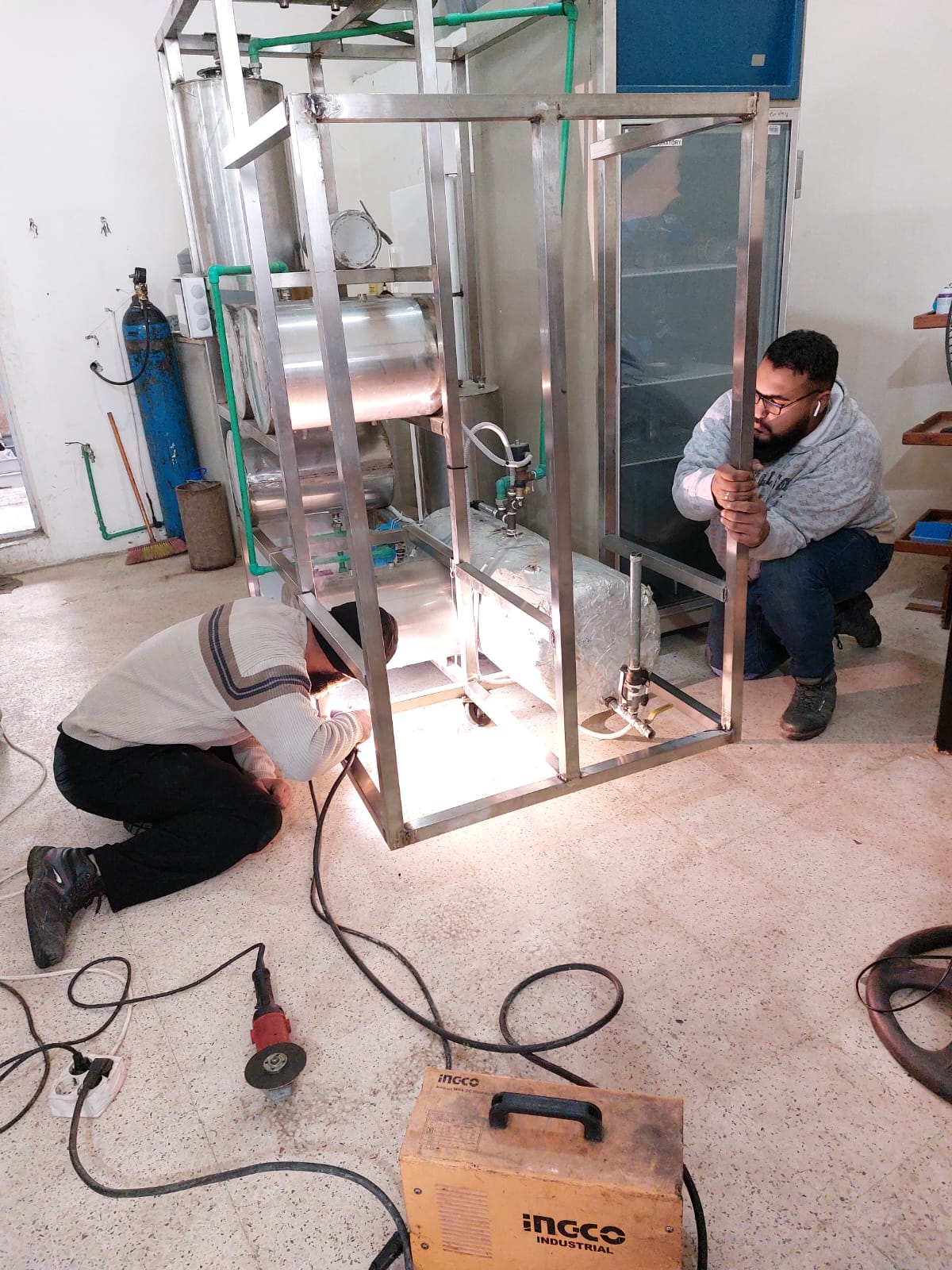

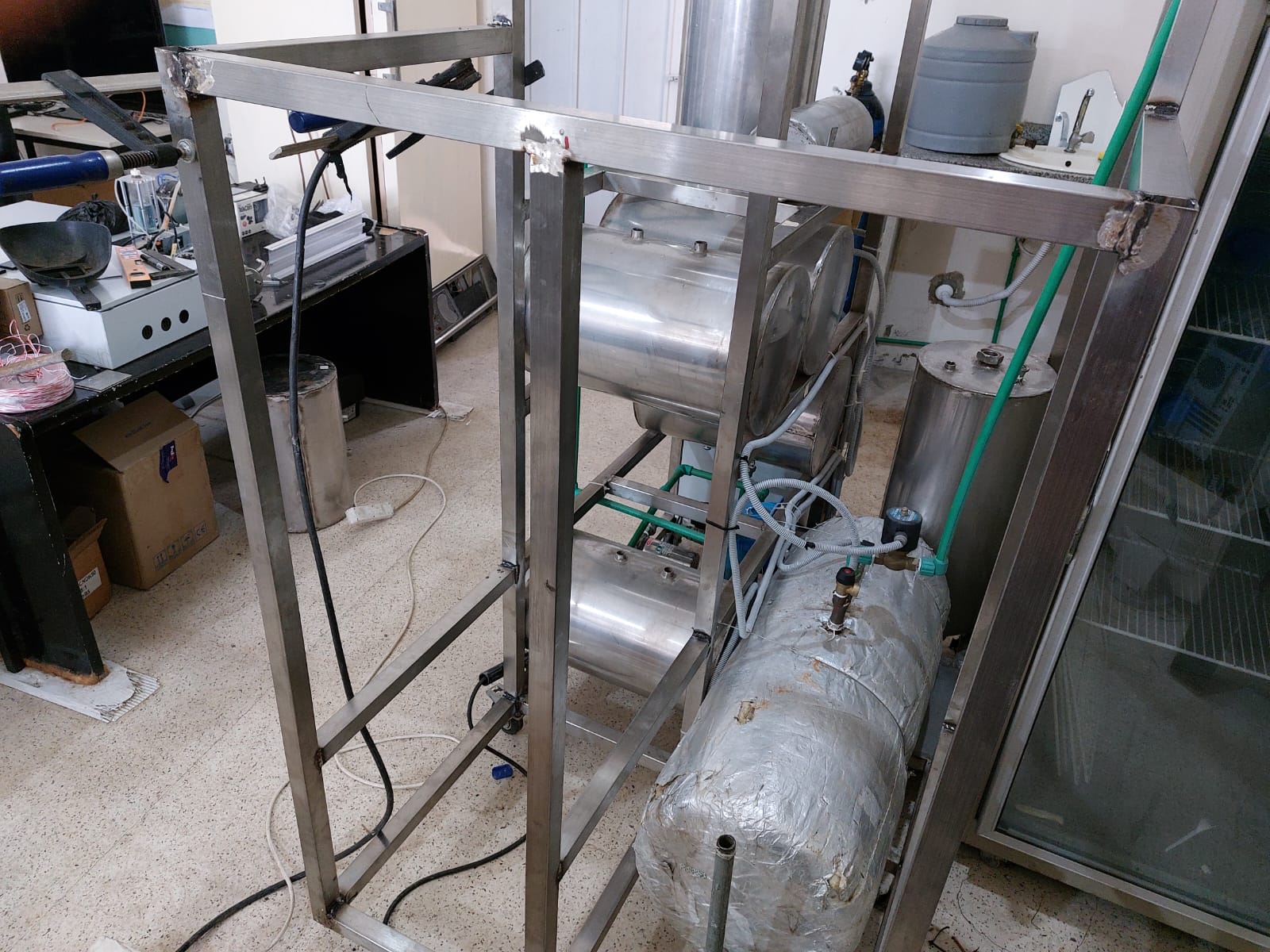

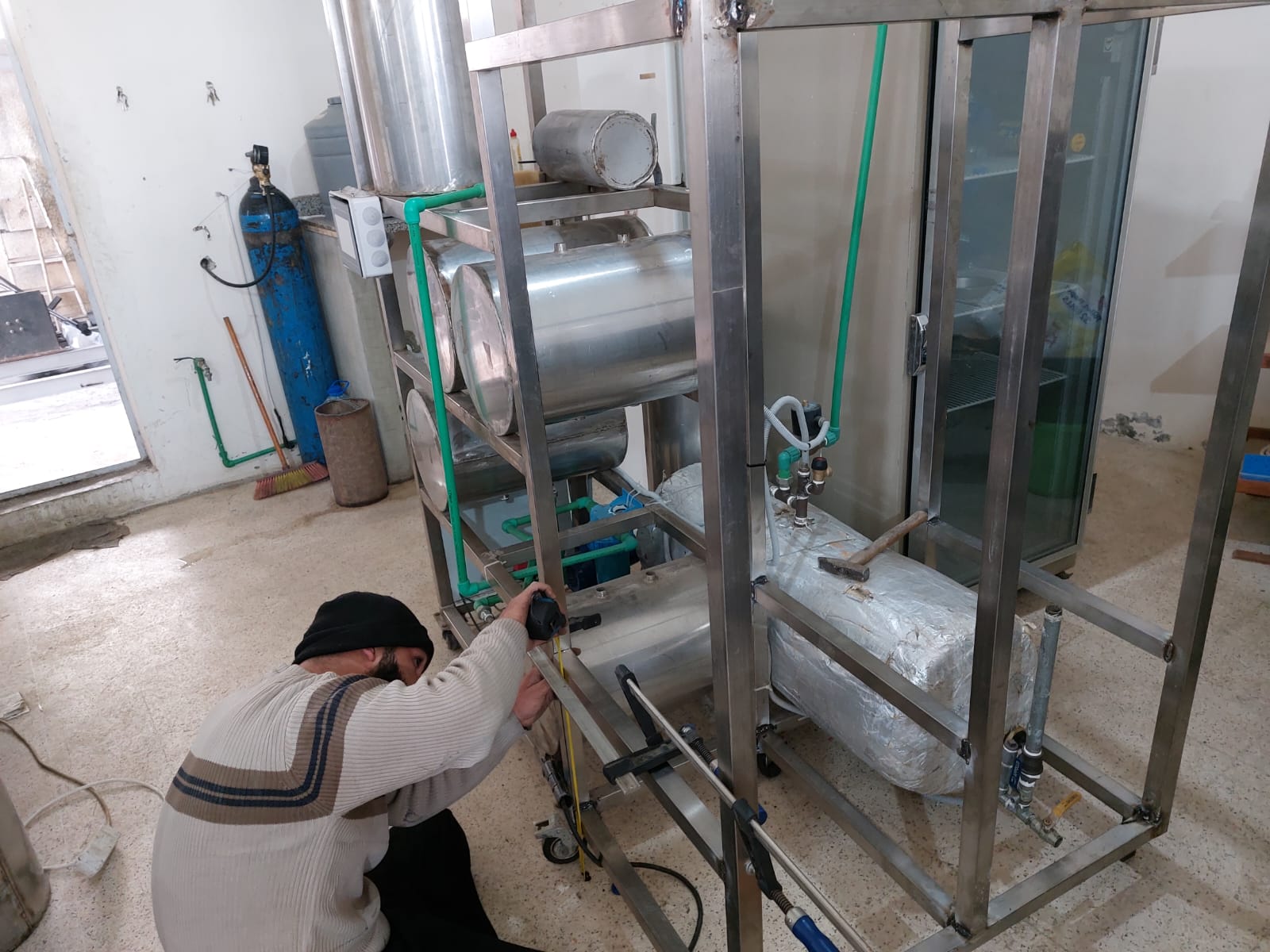

Stand installation : (18/01/2023-07/04/2023)

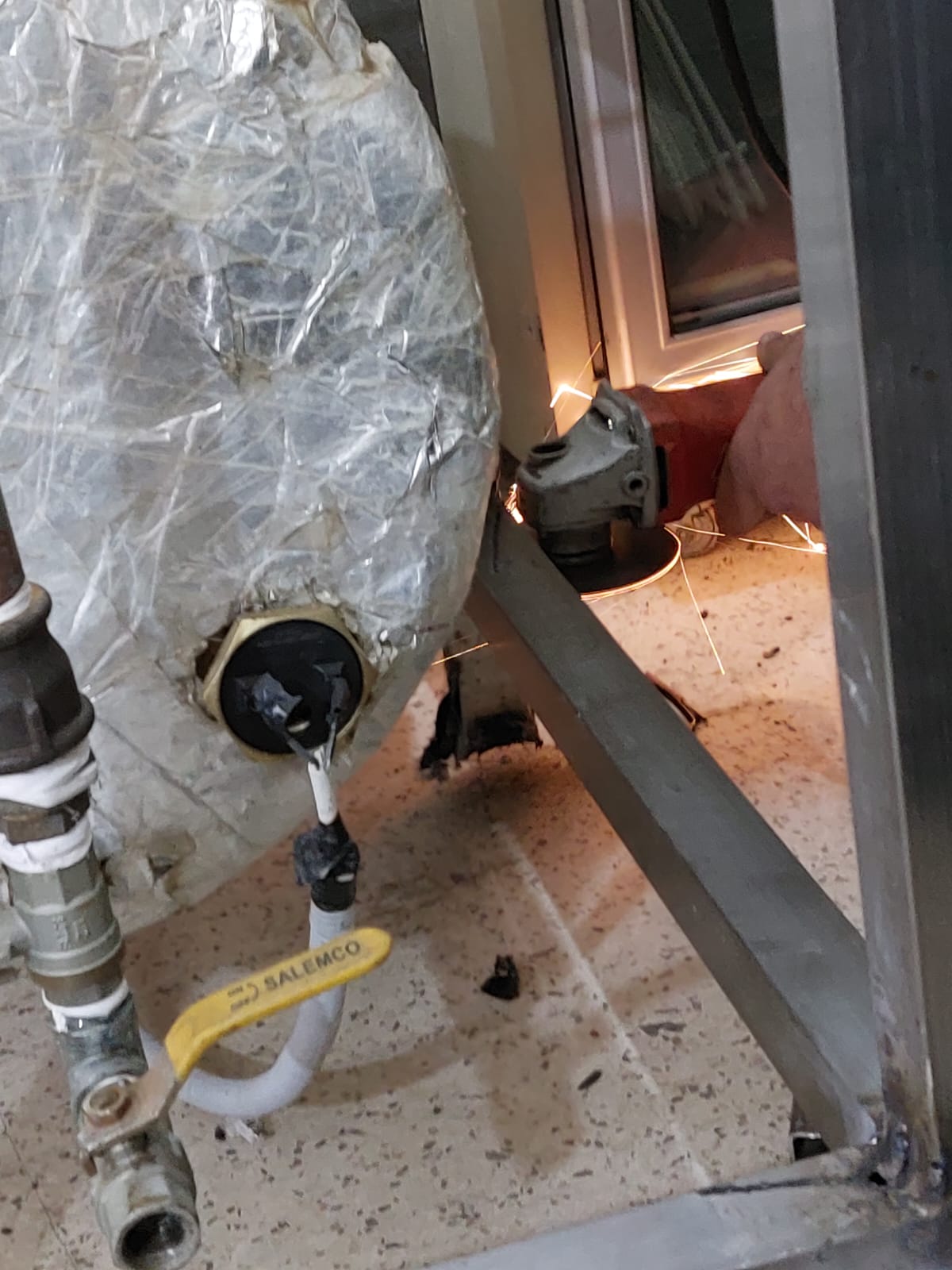

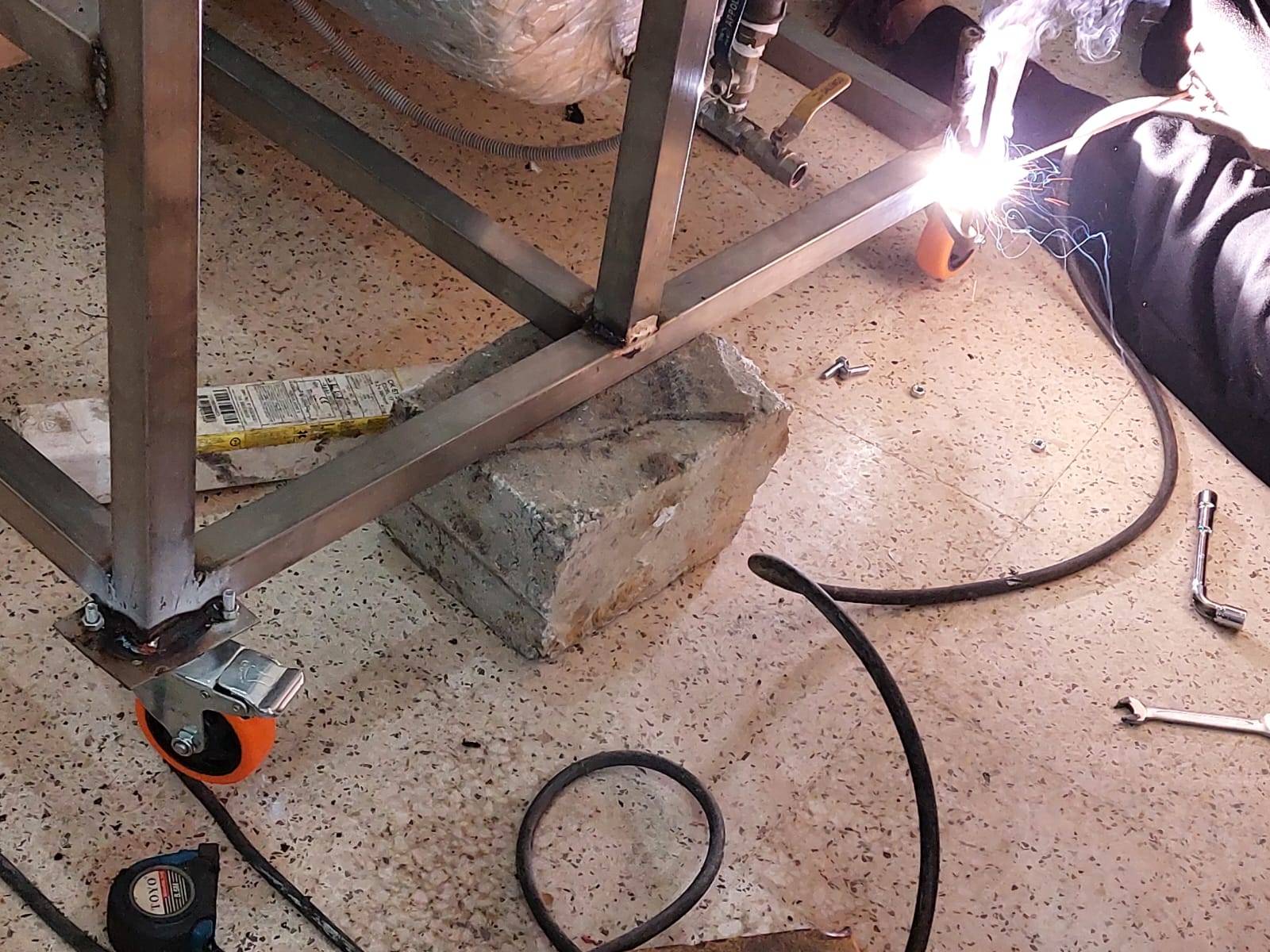

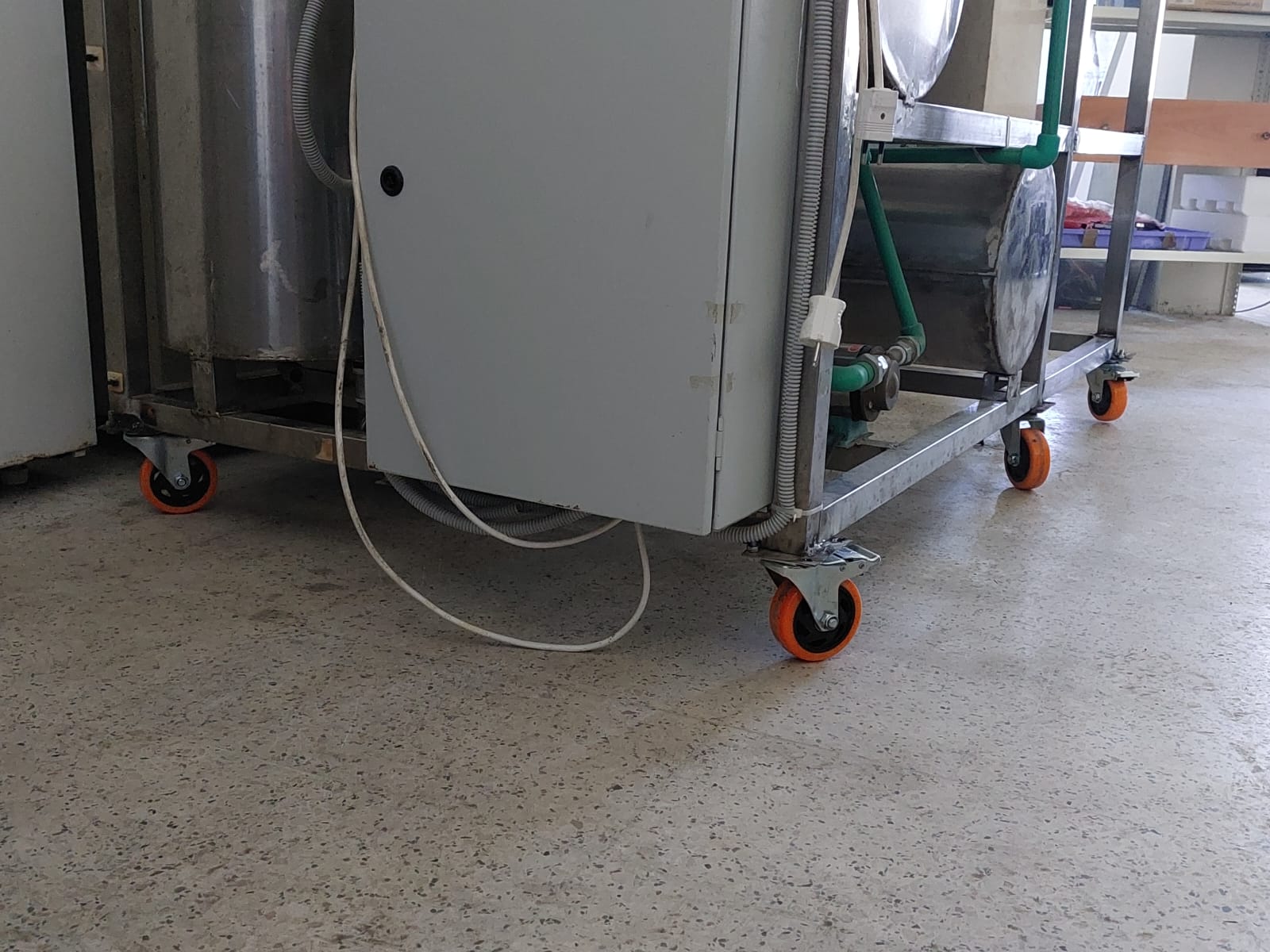

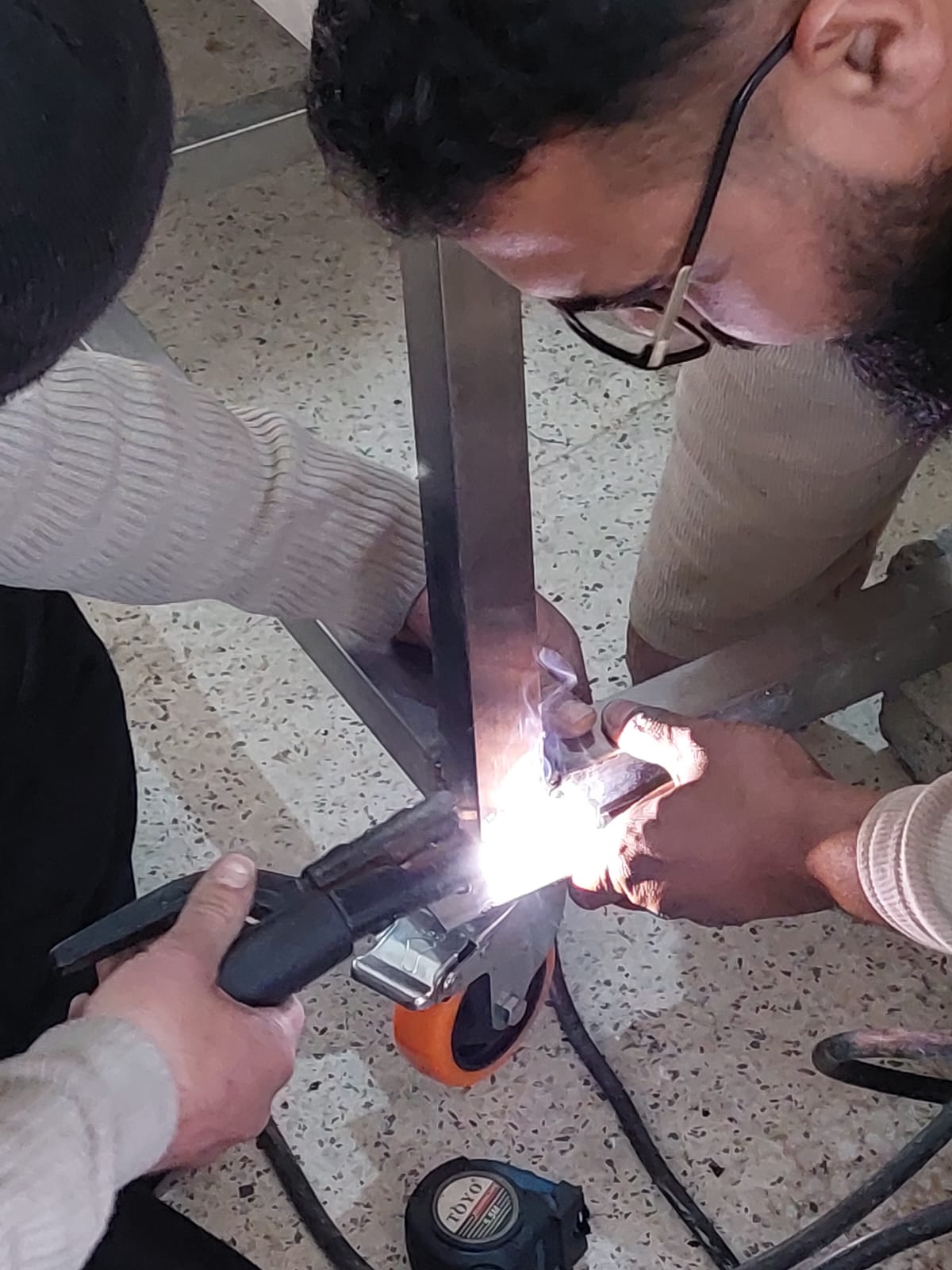

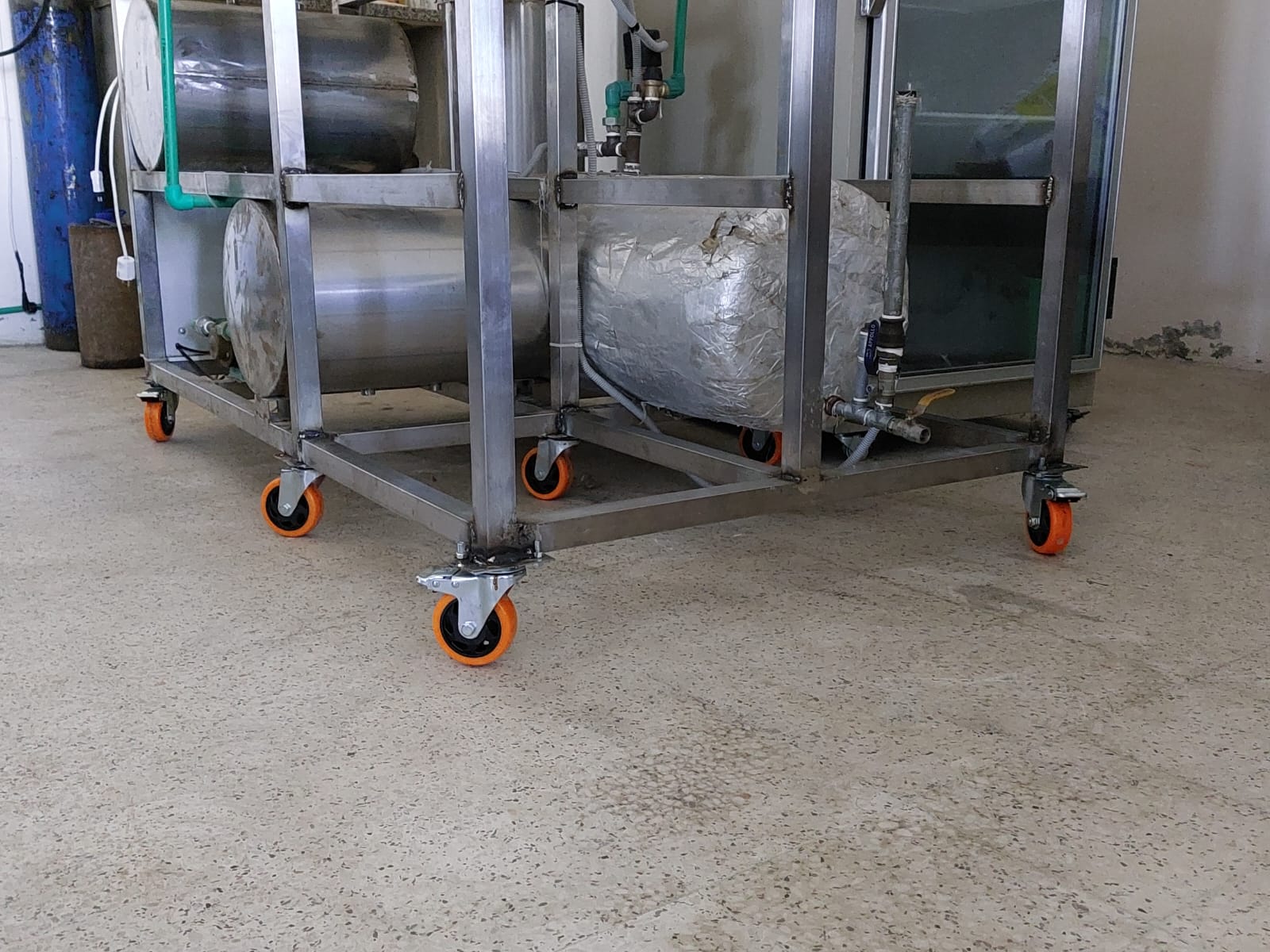

Wheel stand installation :(19/01/2023)

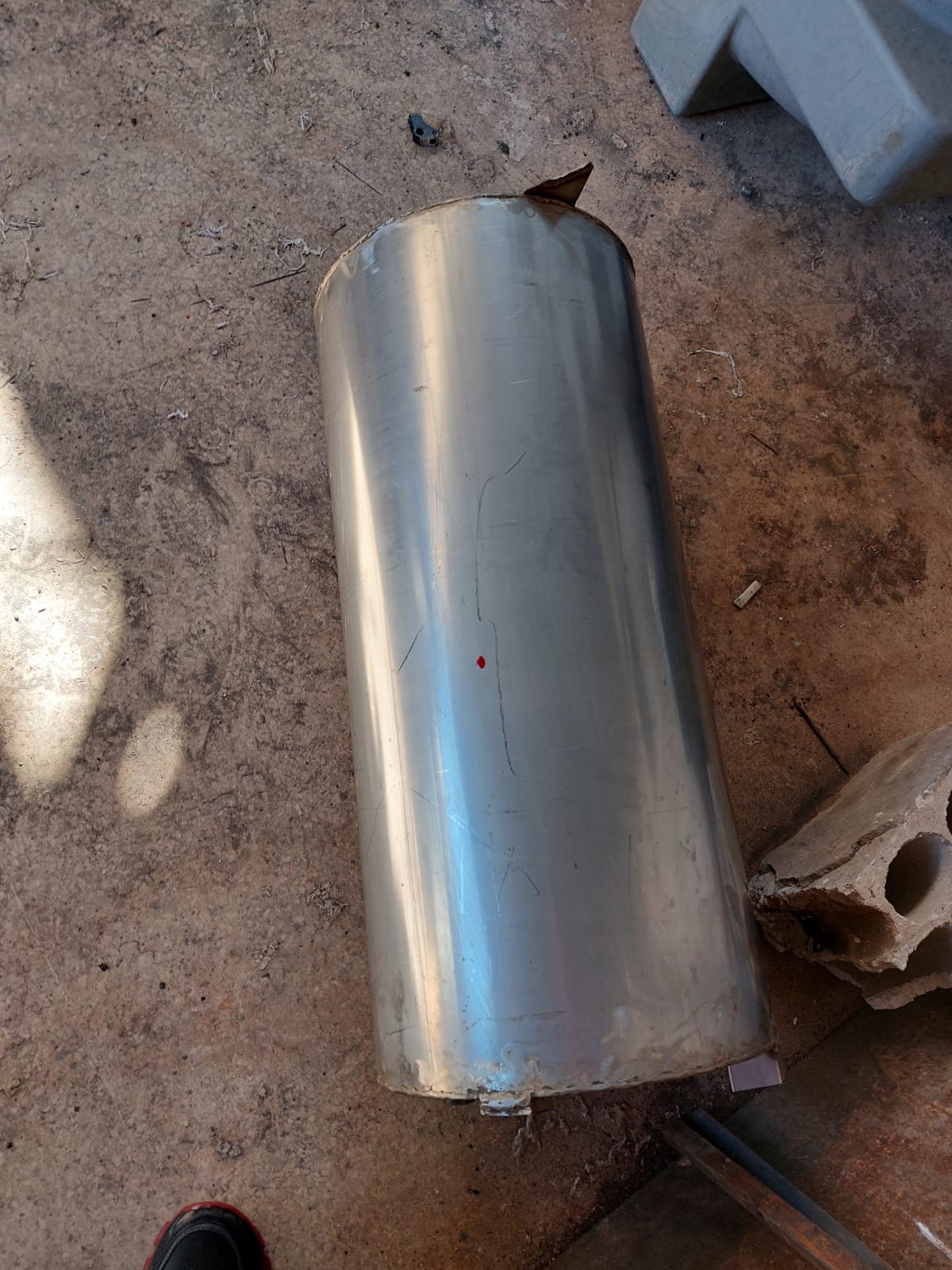

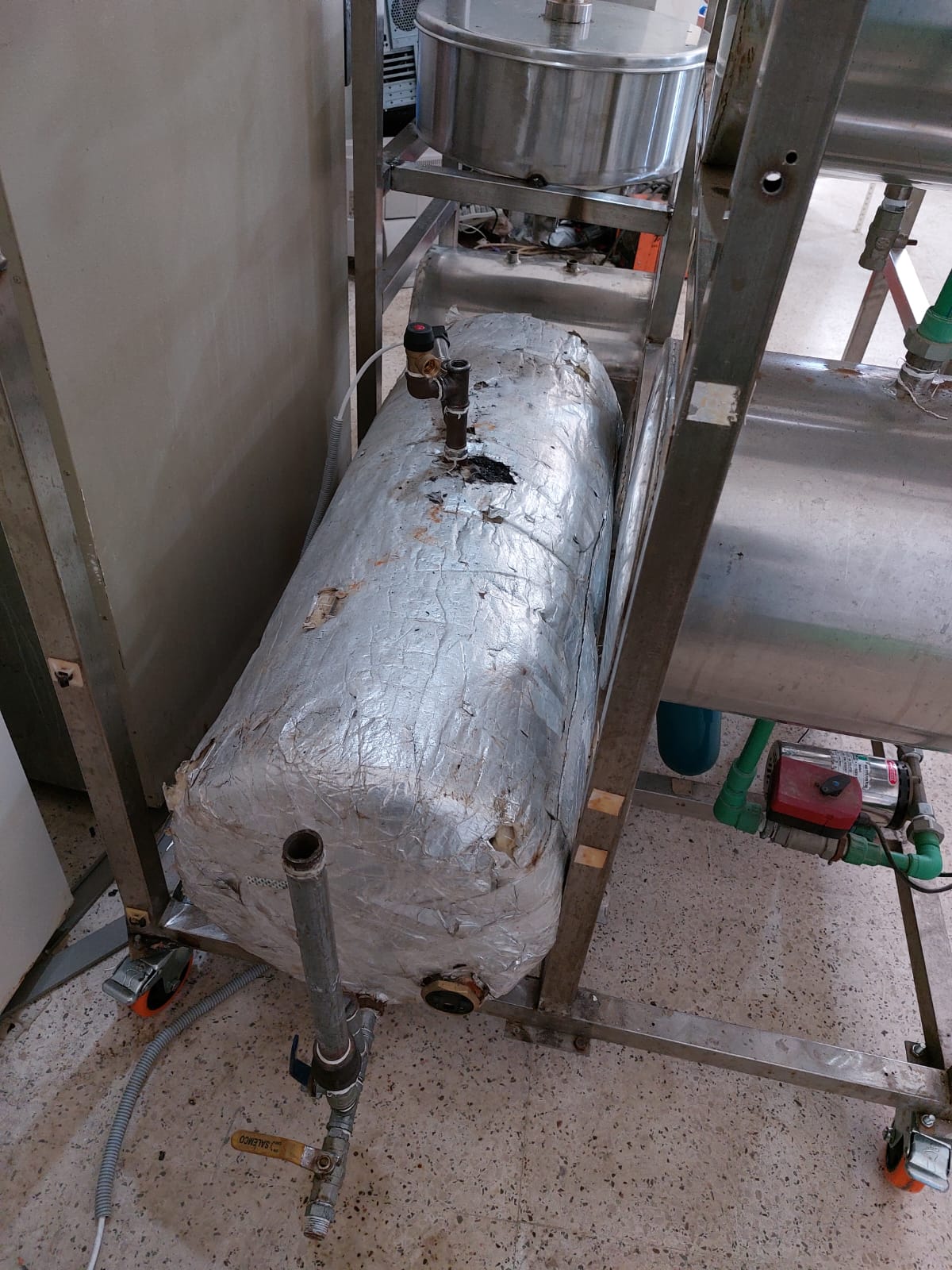

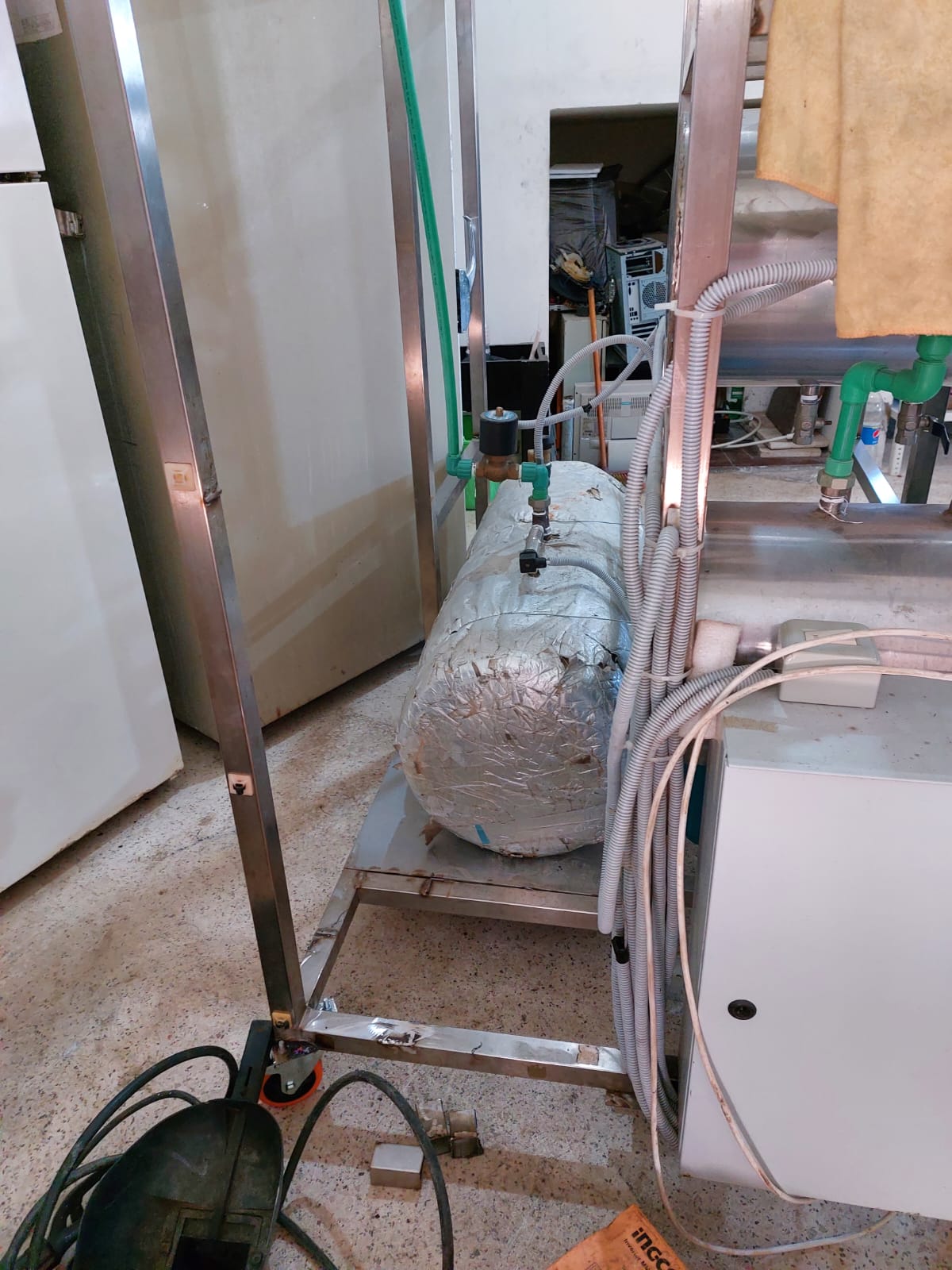

Autoclave place editing :(20/01/2023)

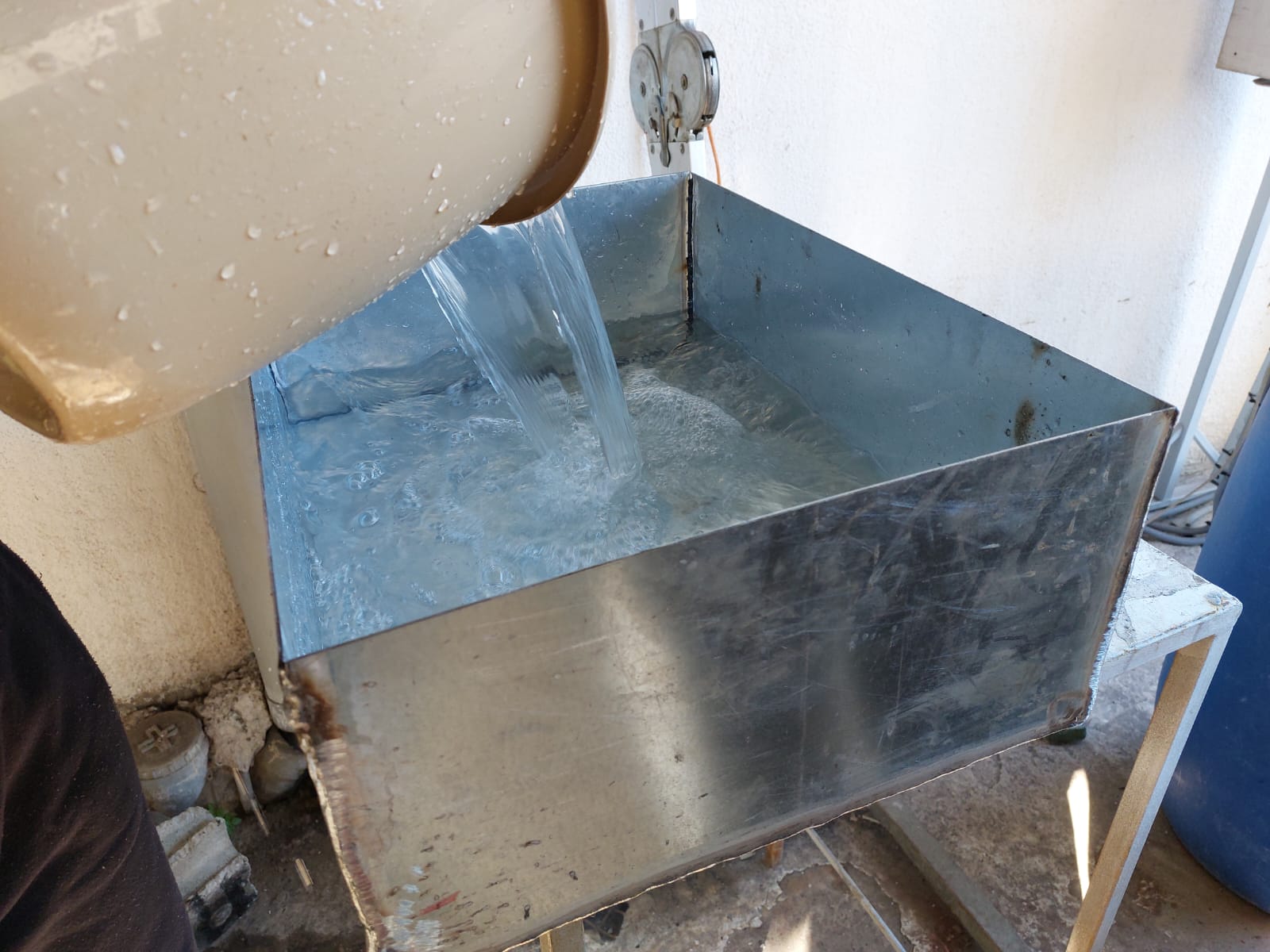

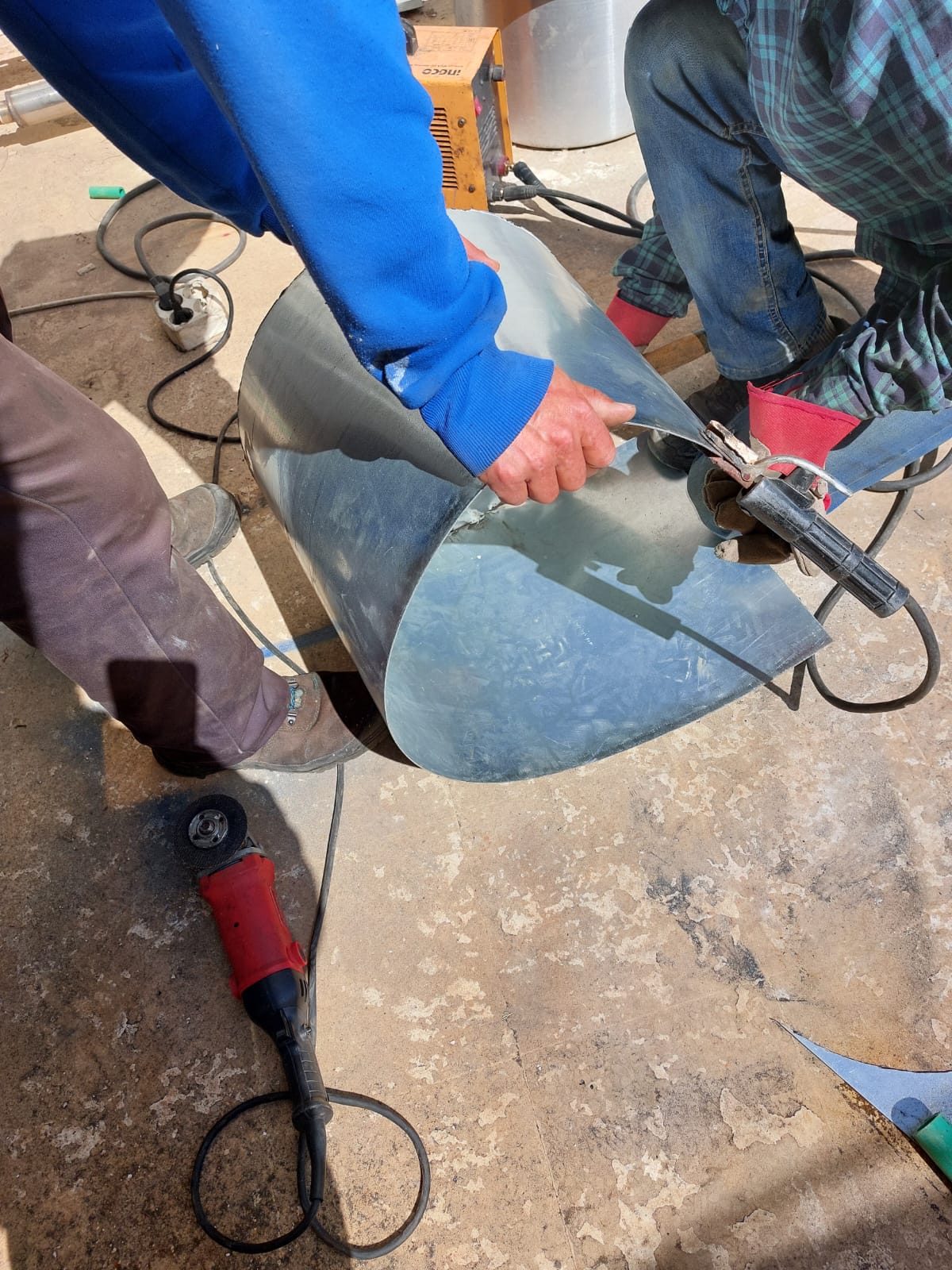

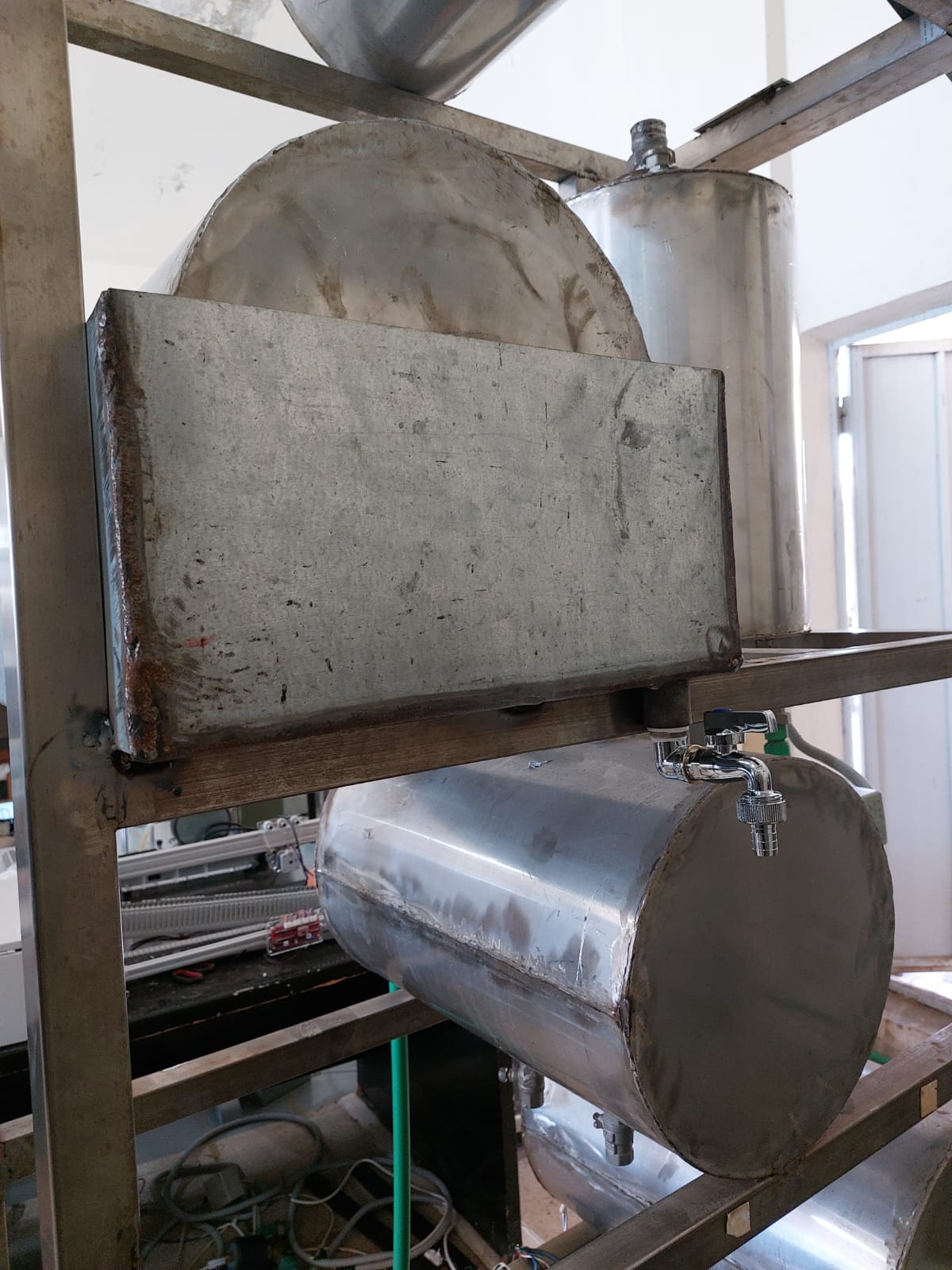

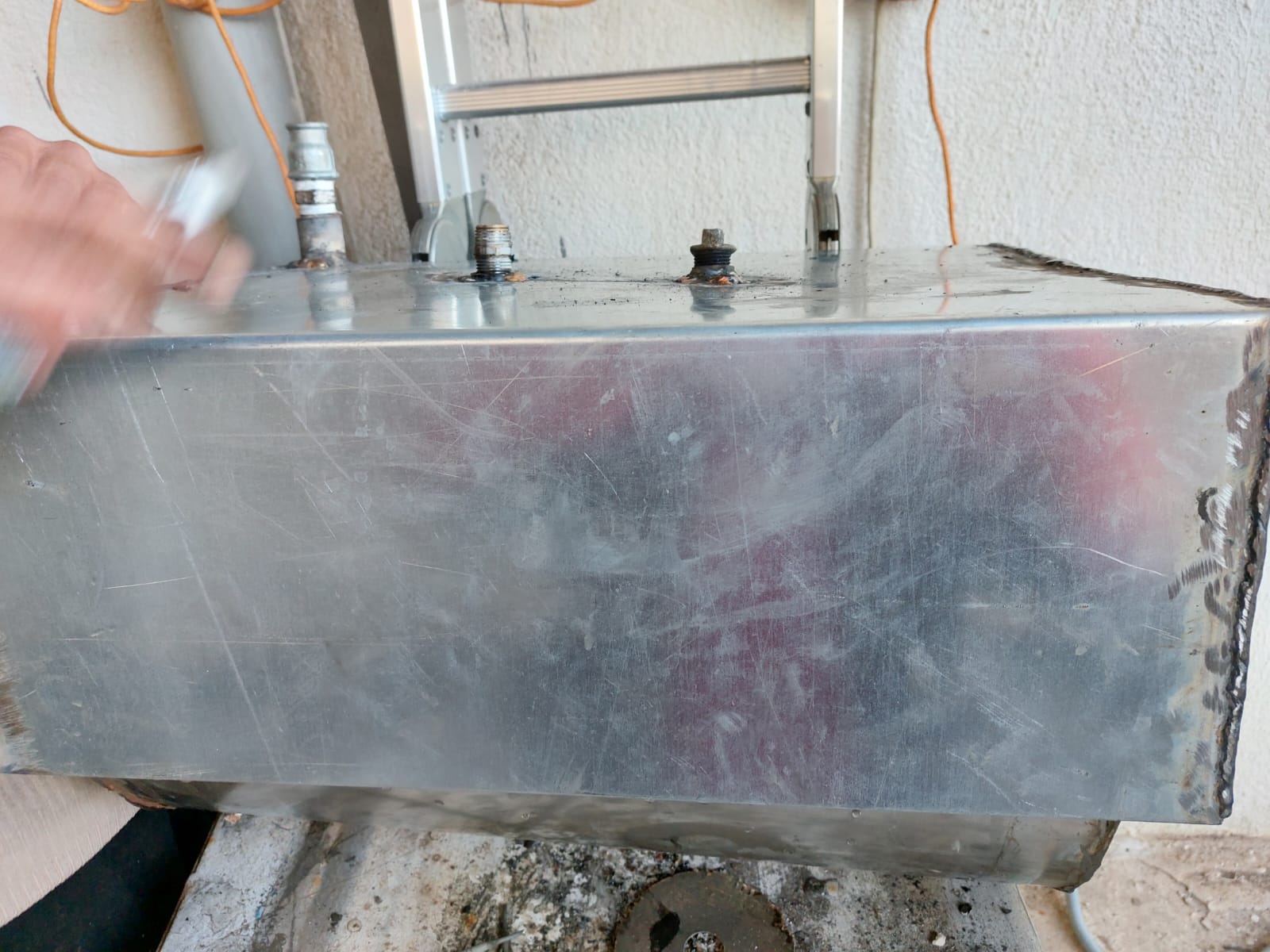

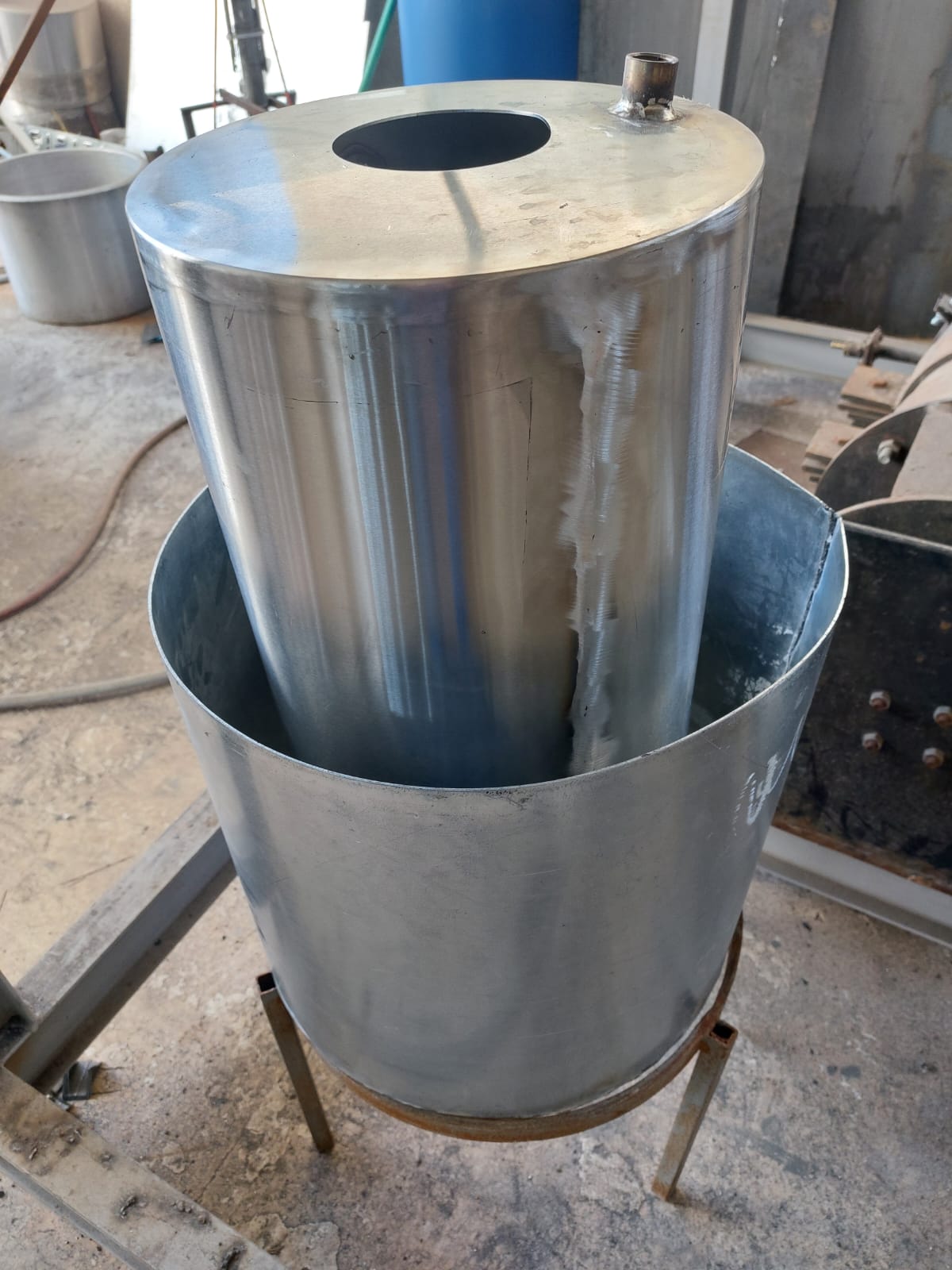

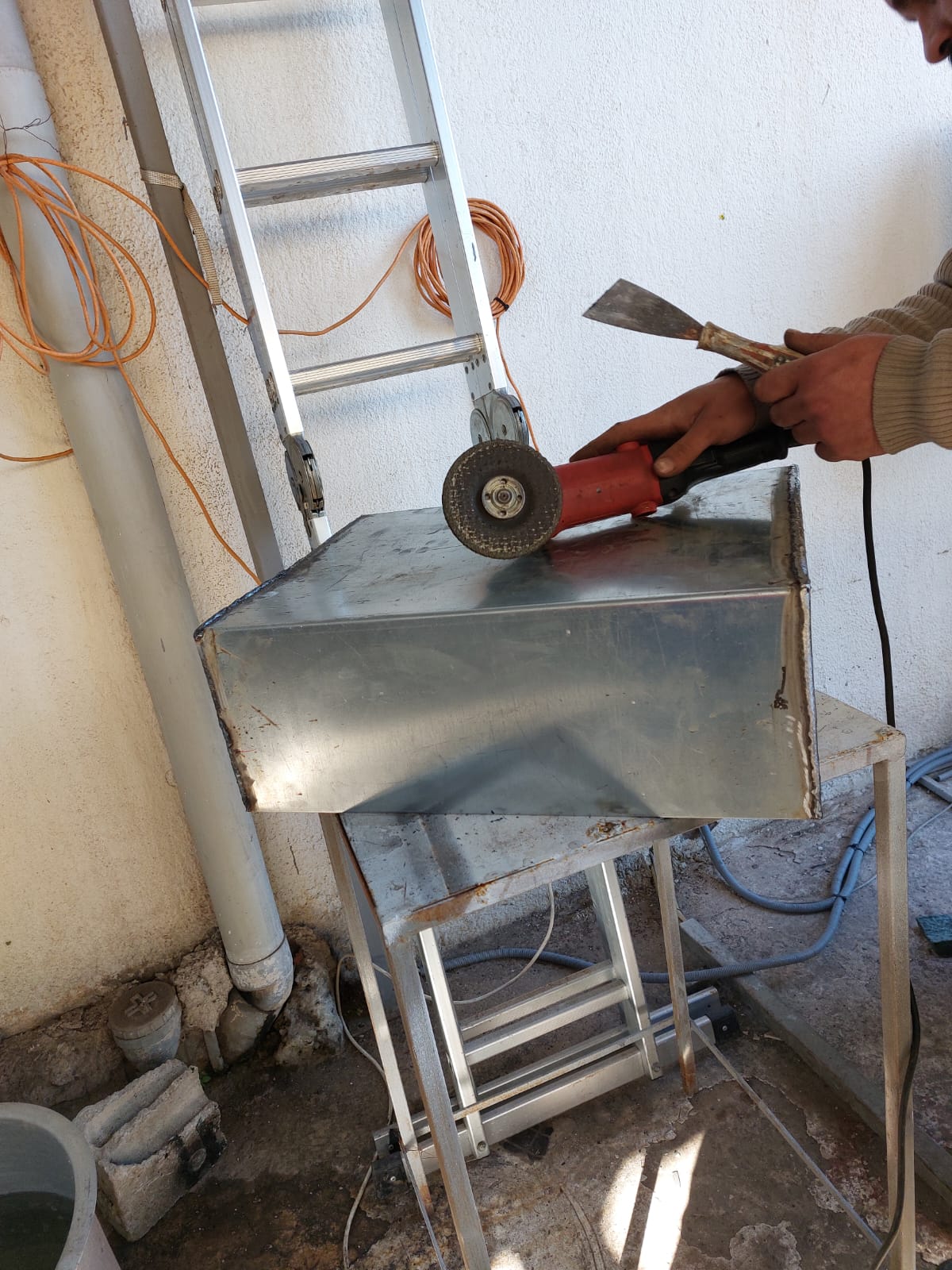

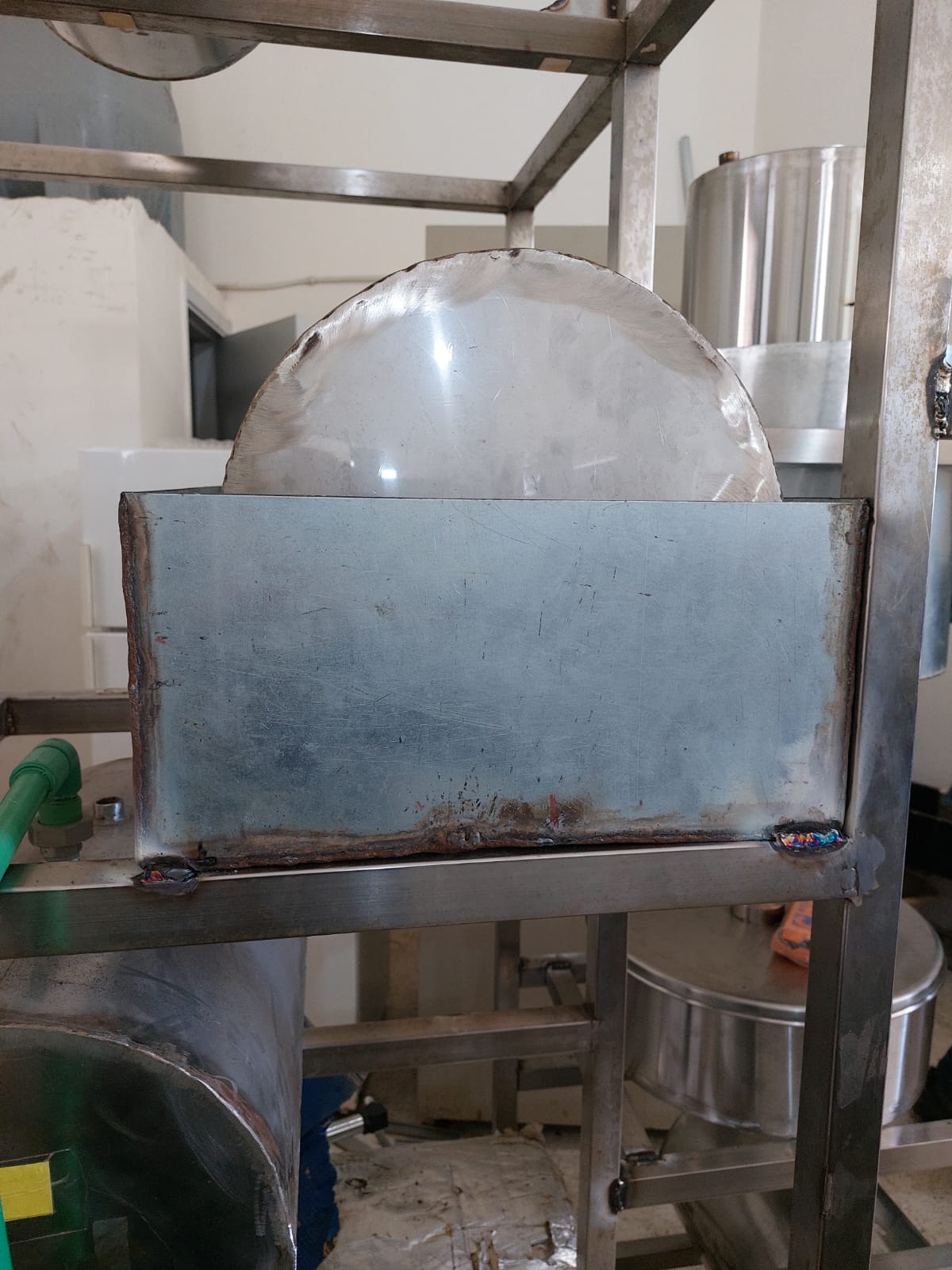

Bath for tank 2 (cooler) + tank 3 (crystallizer) and testing :(22/01/2023)-(04/07/2023)

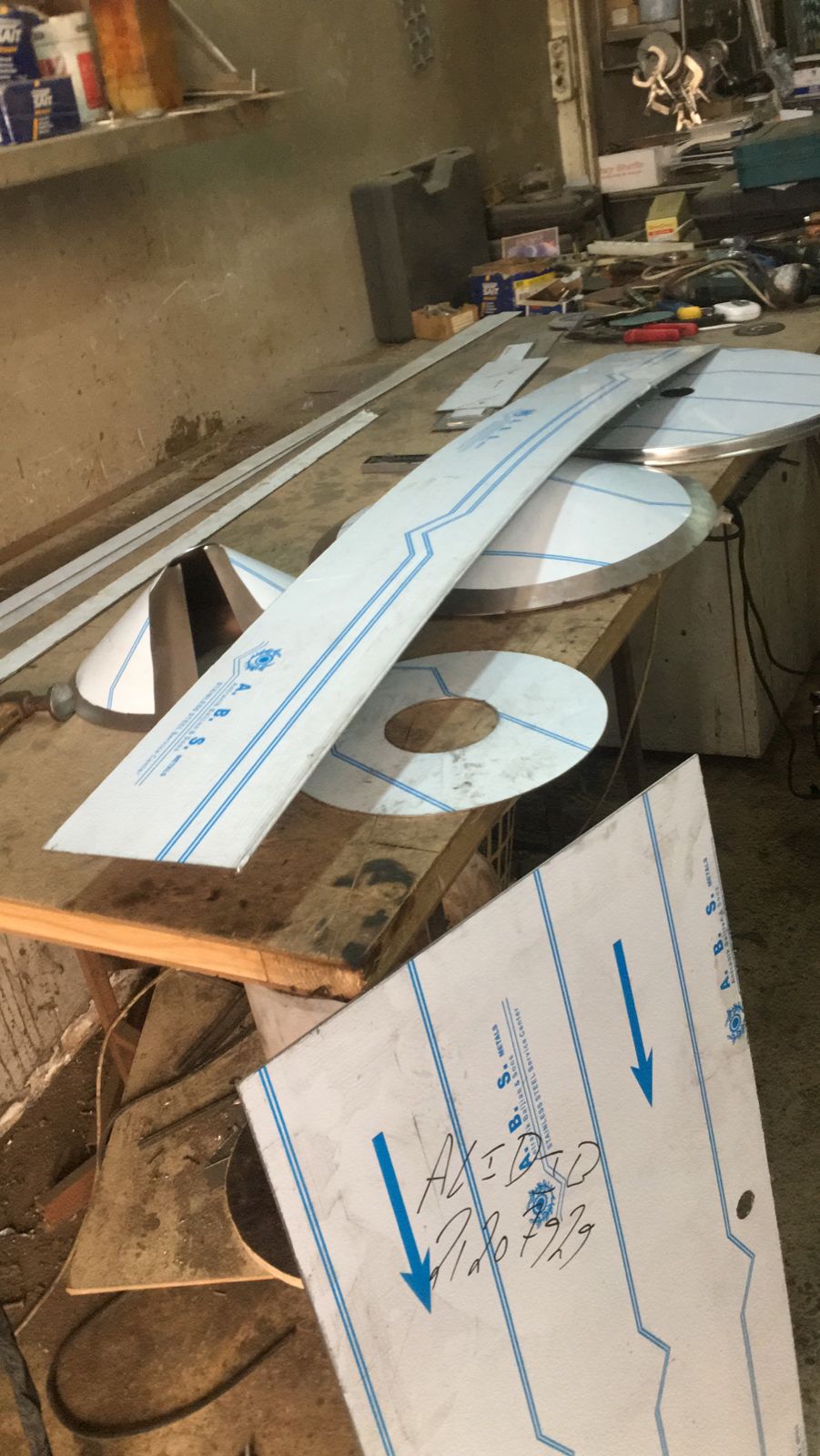

Crystallizer and Filter equipements:(07/03/2023)

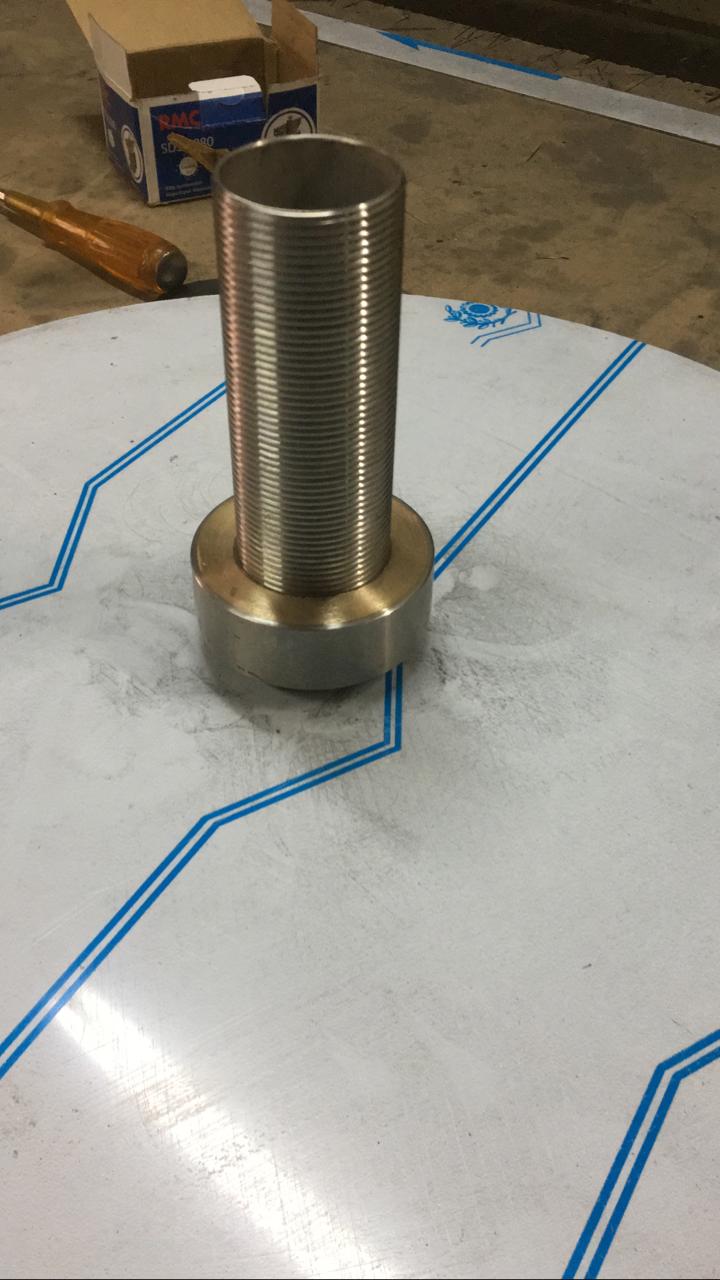

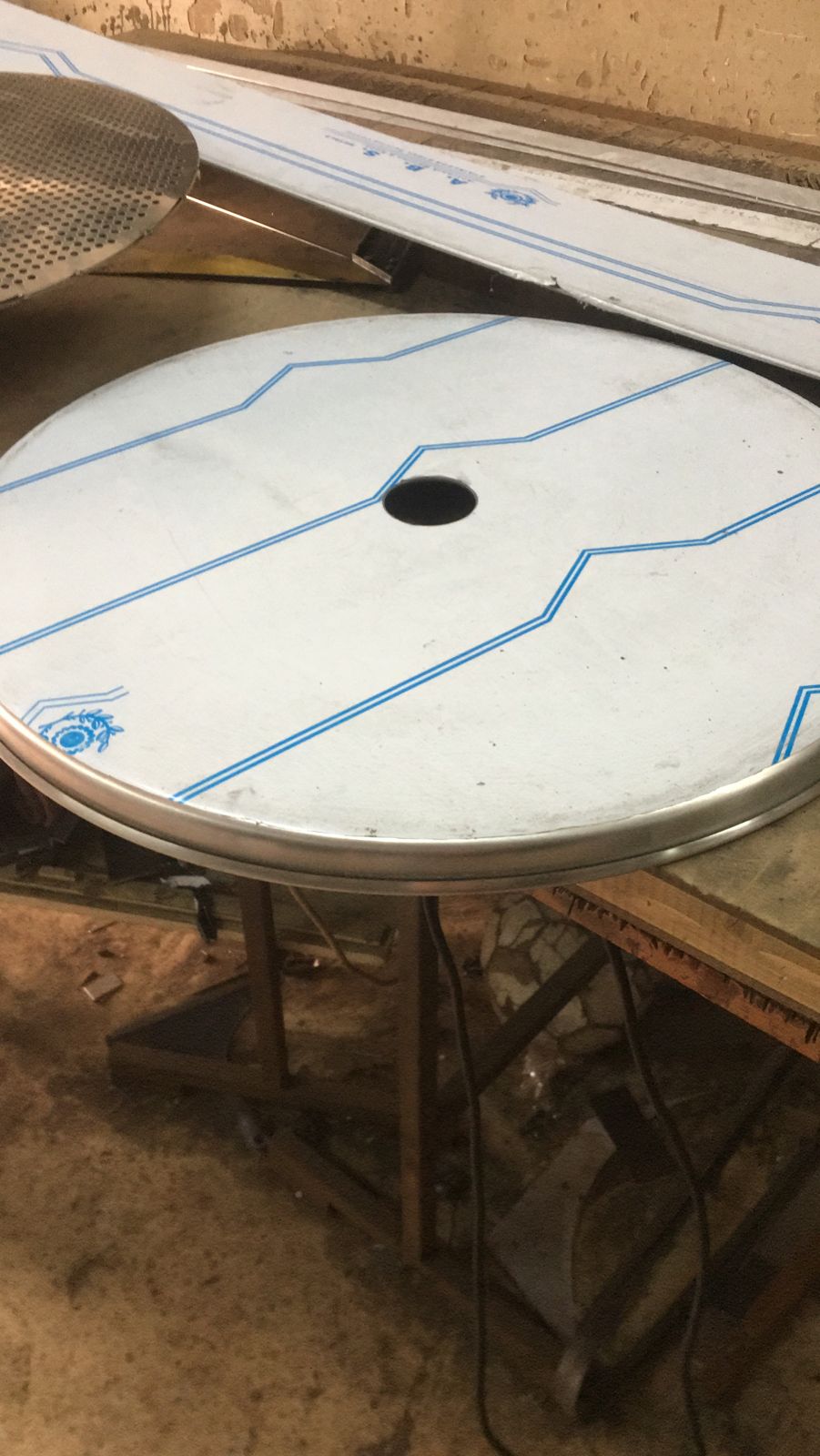

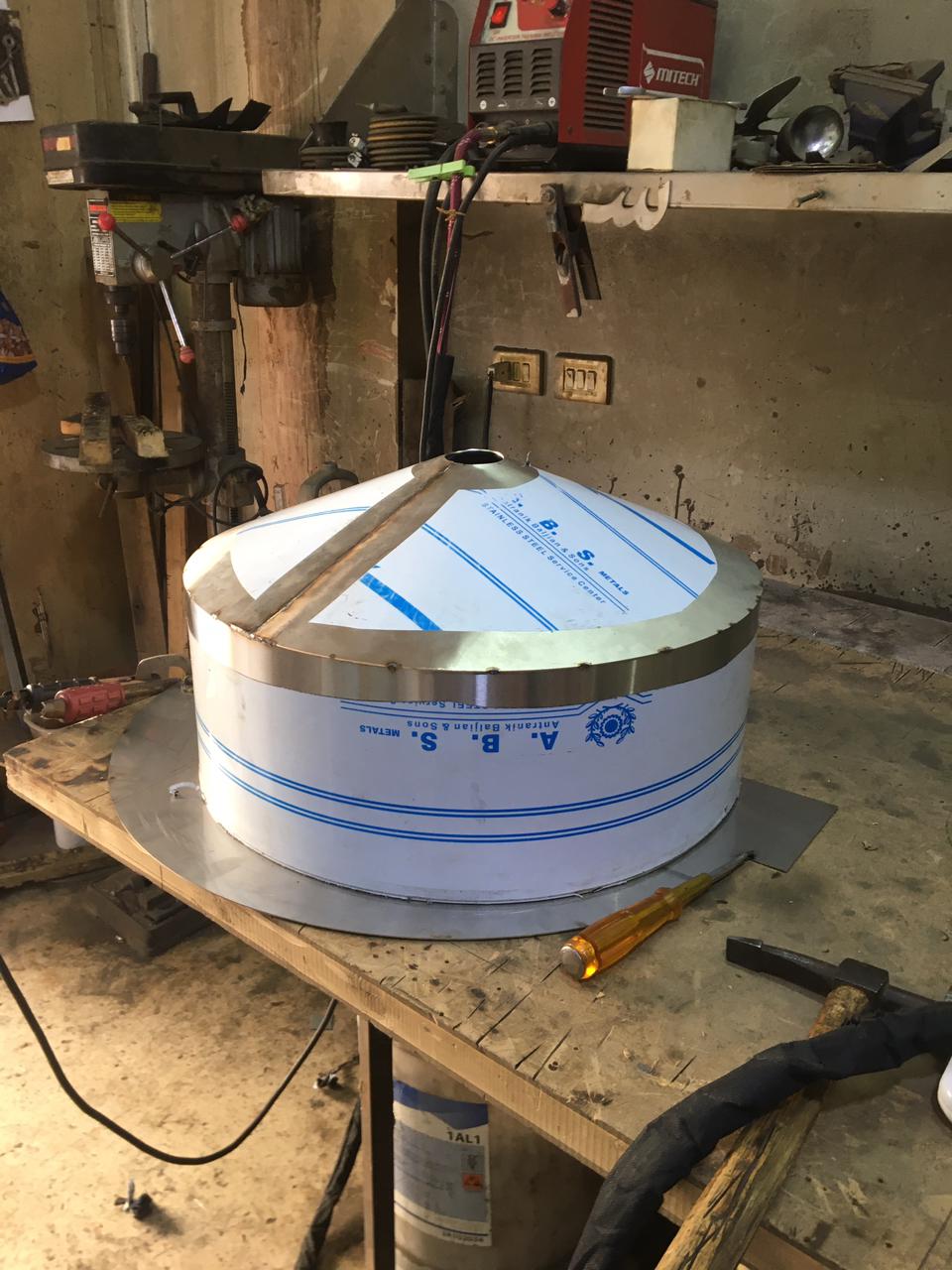

Cover for vacuum filter :(09/03/2023)

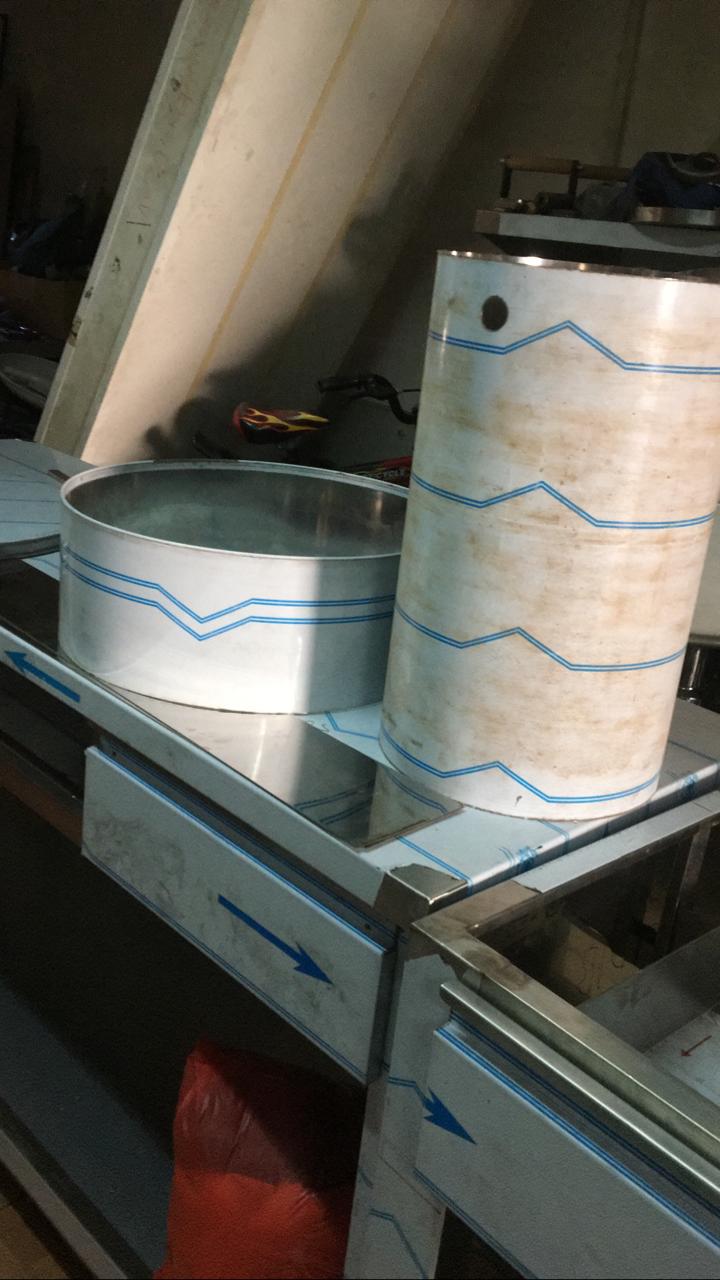

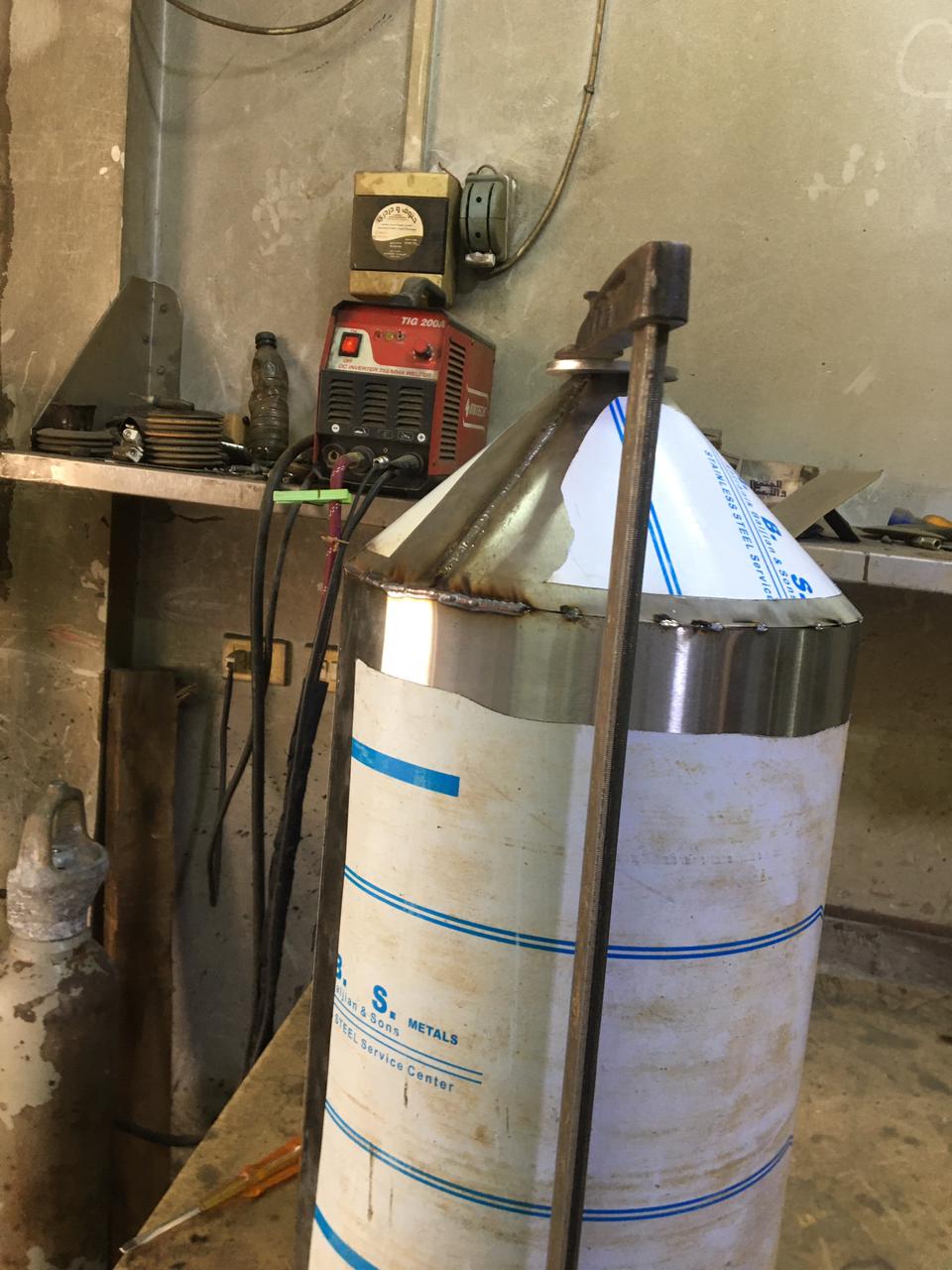

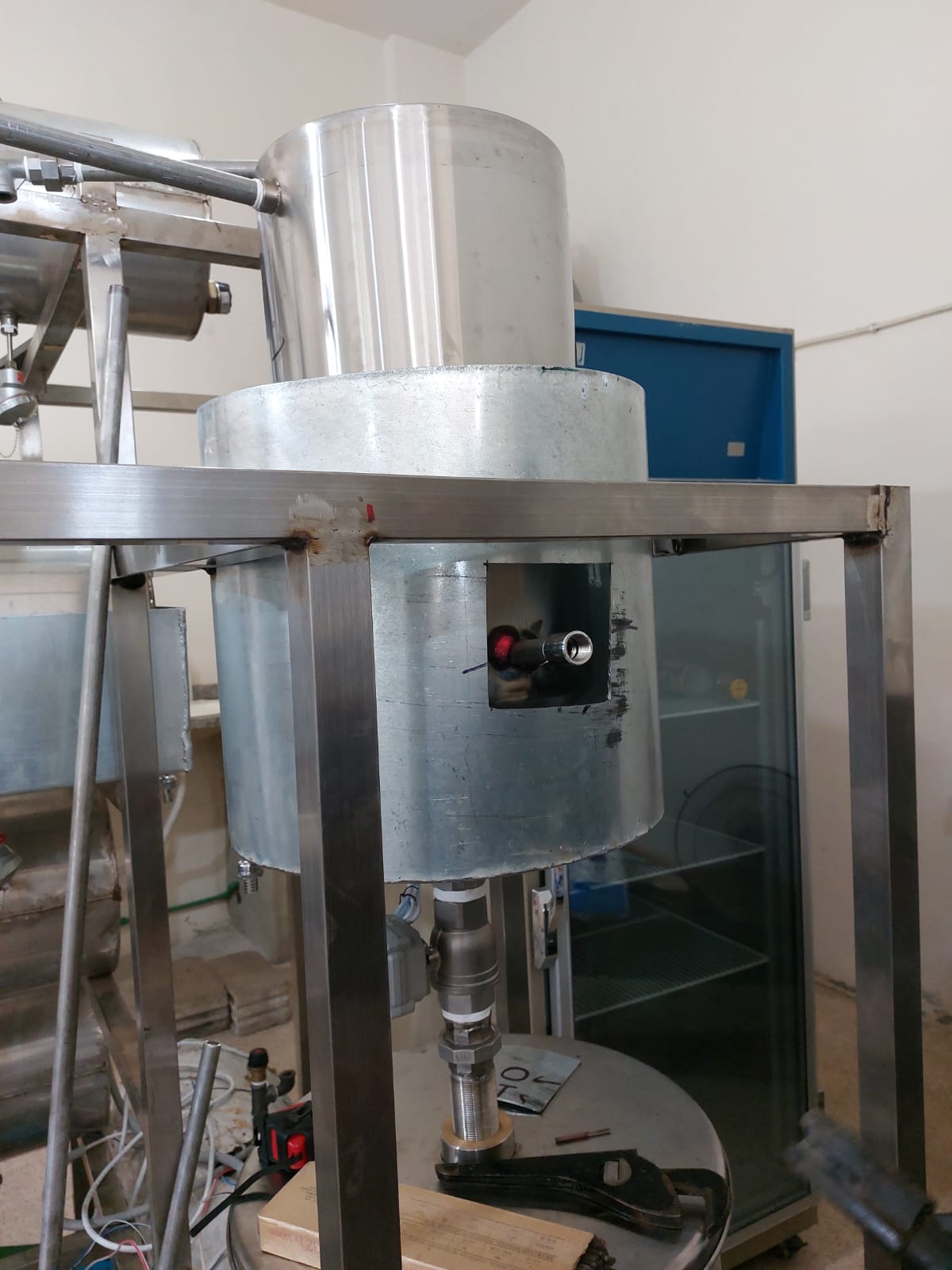

crystallizer tank and the filter tank :(09/03/2023)

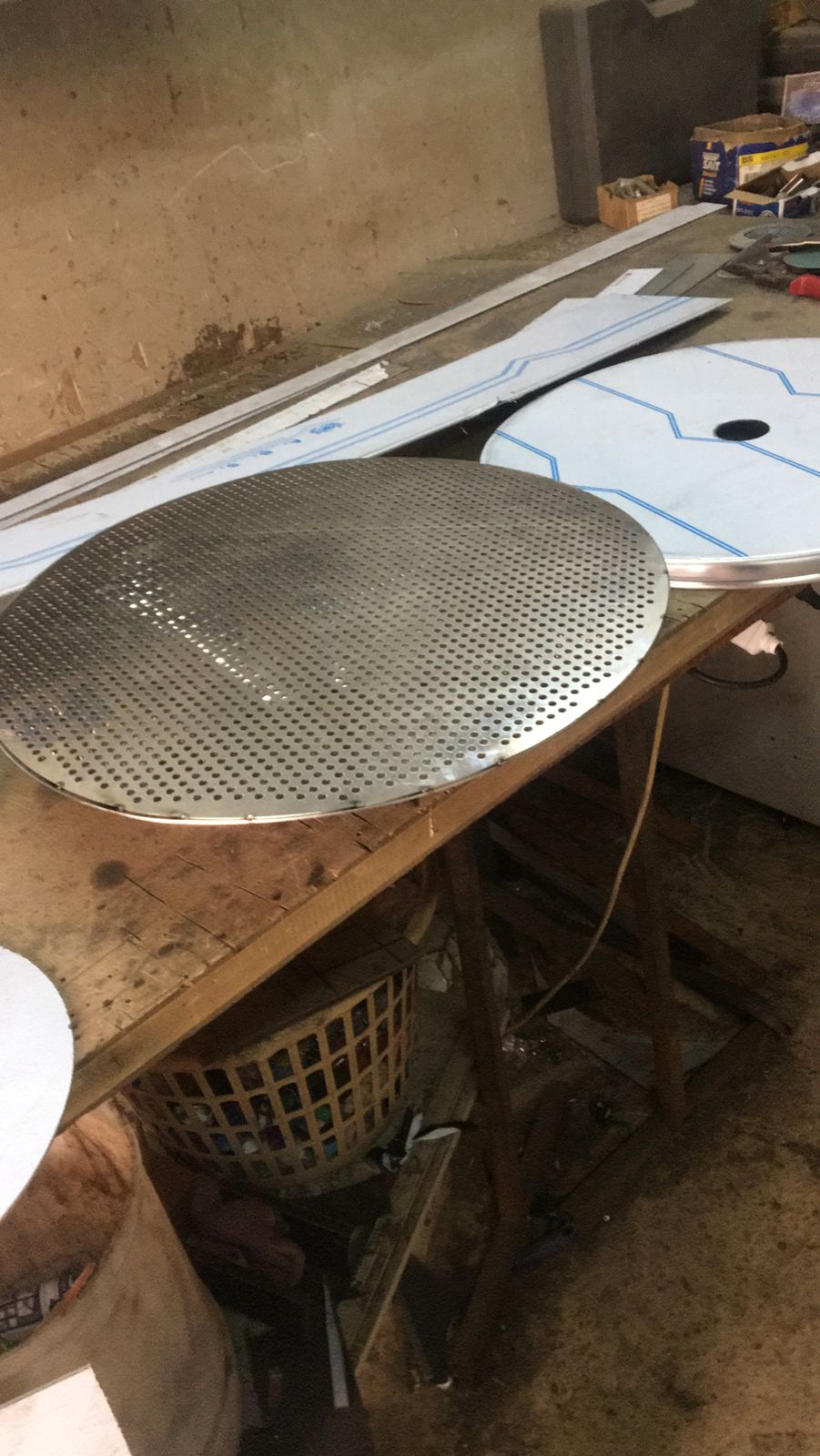

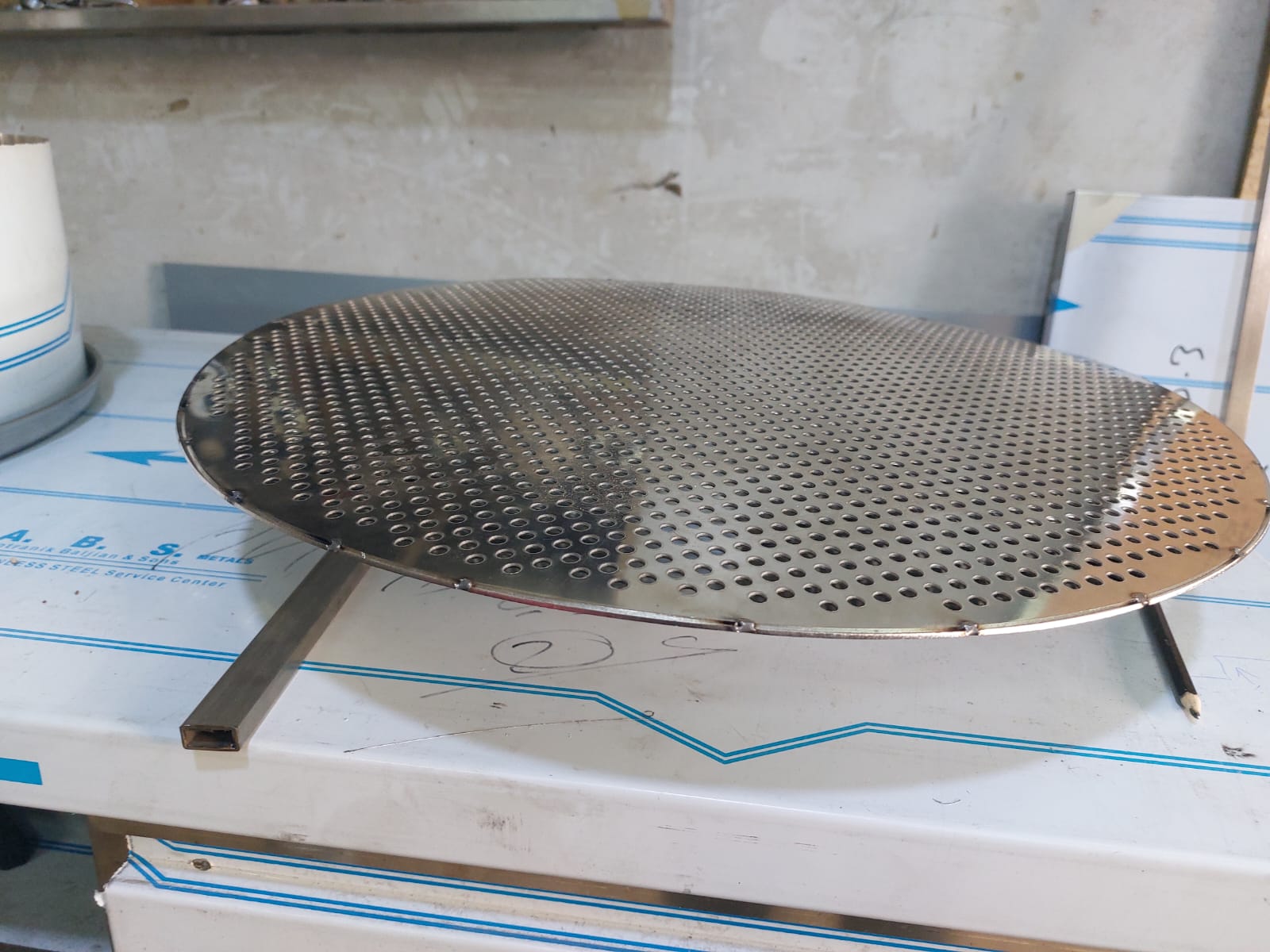

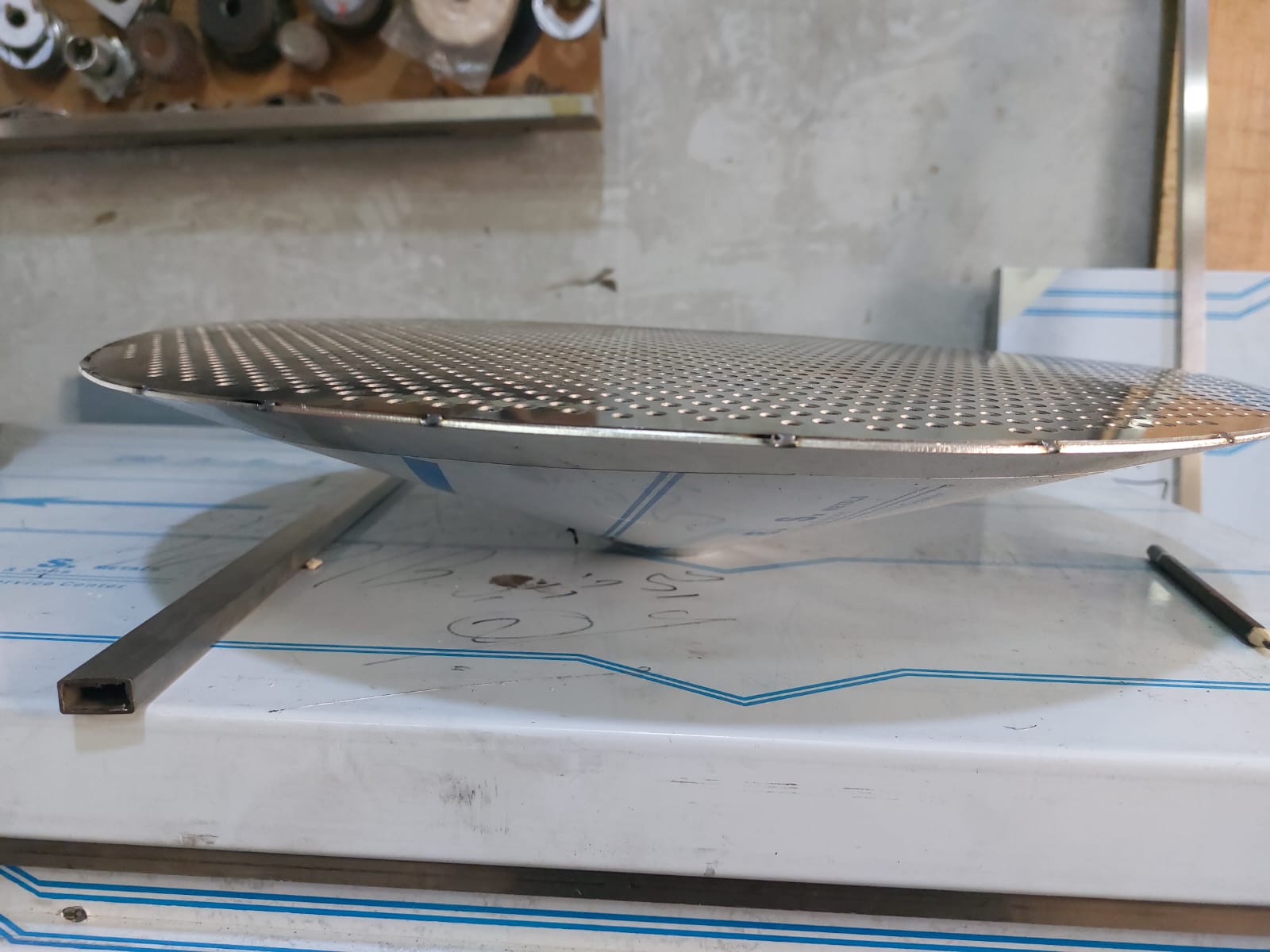

Sieve and the filter con :(13/03/2023)

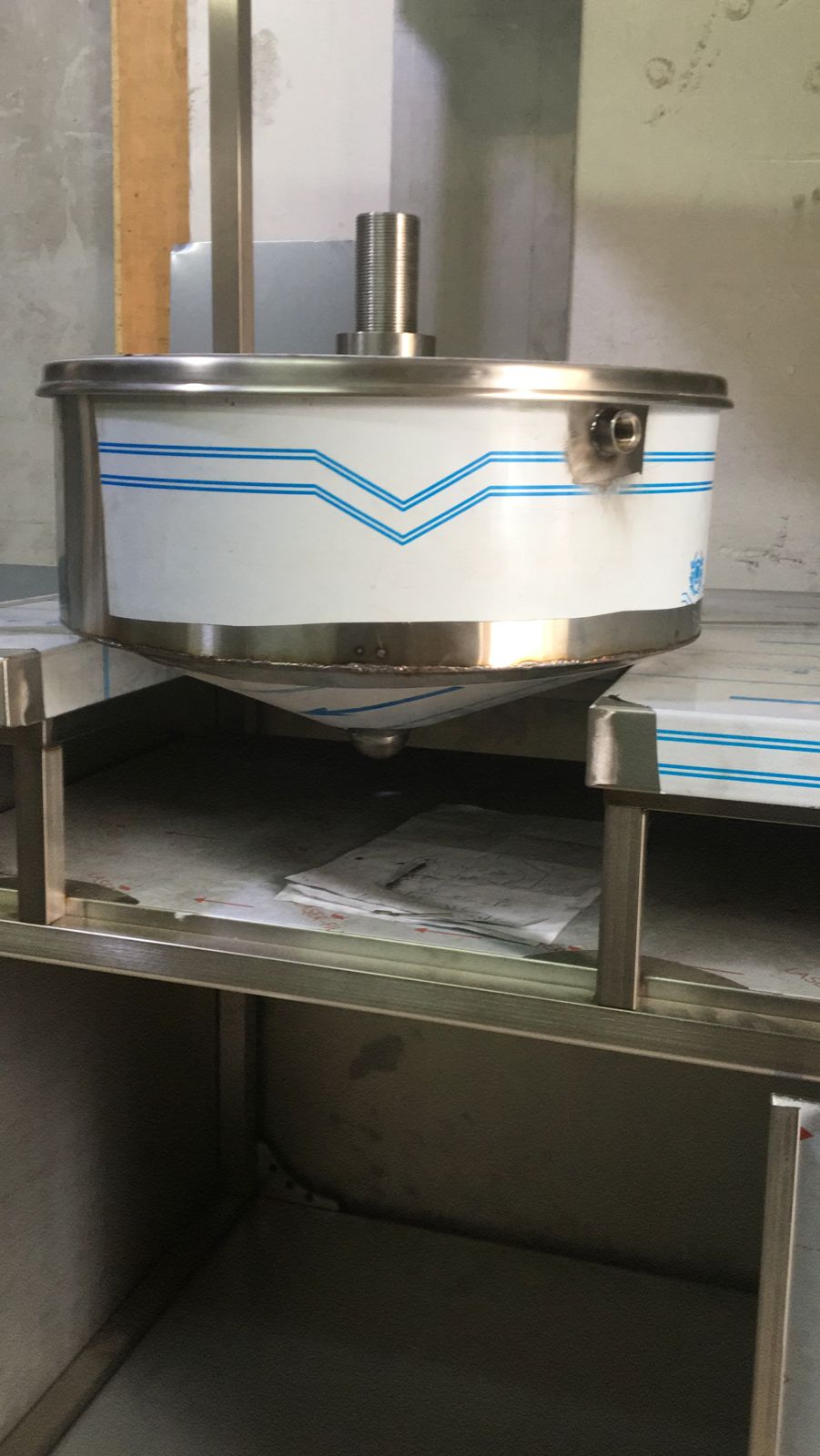

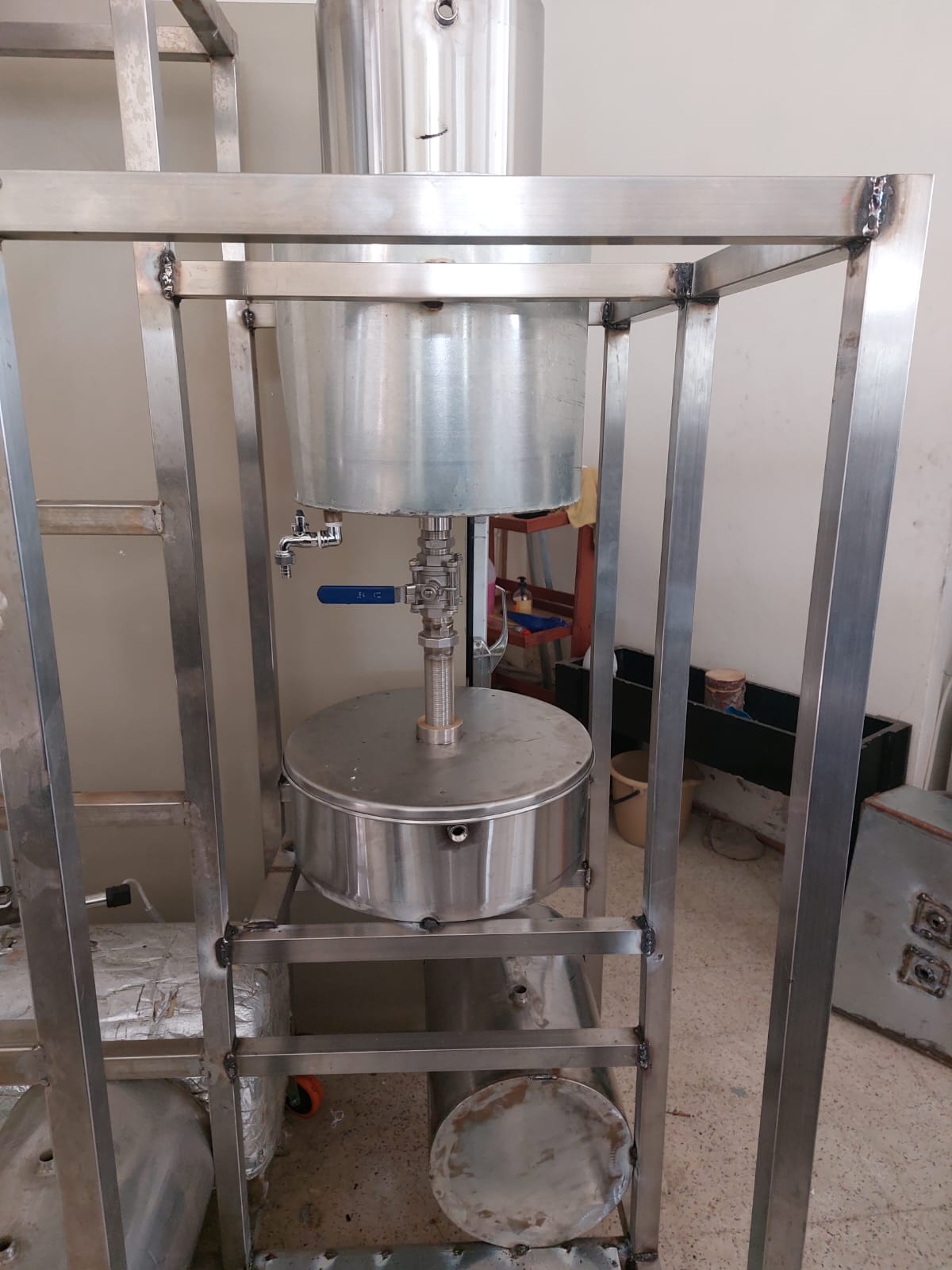

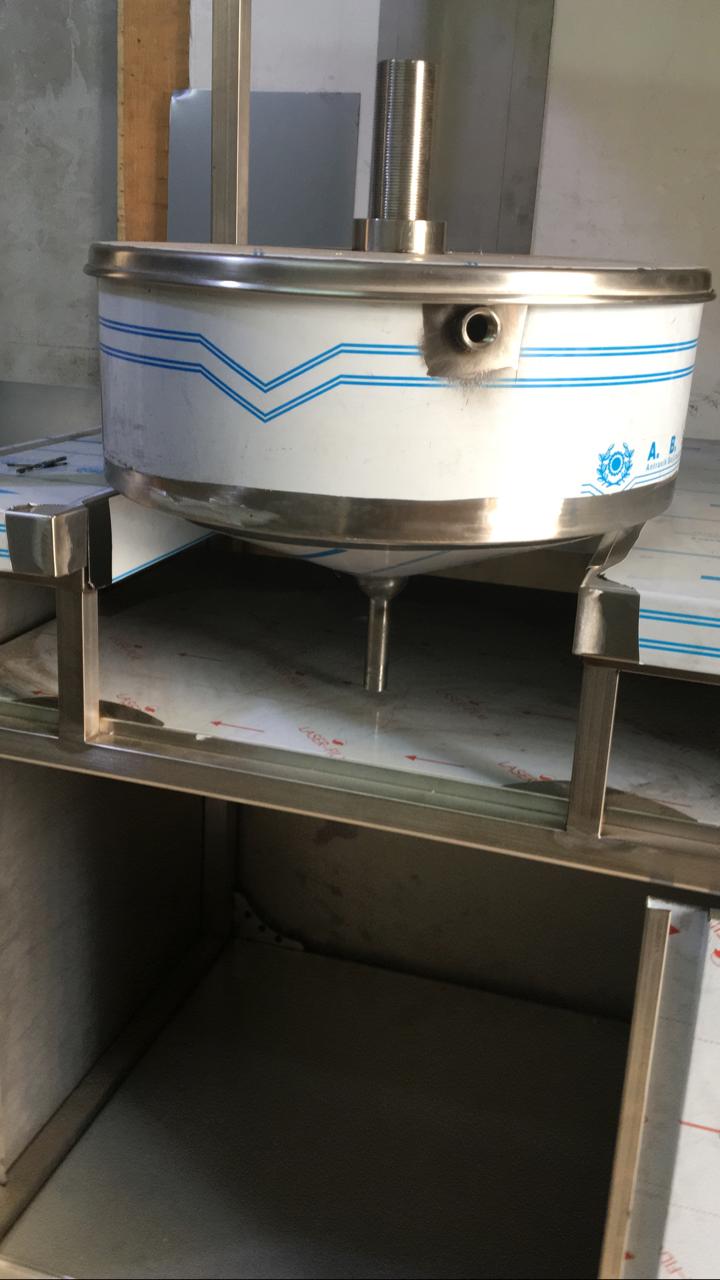

Vacuum filter realisation :(17/03/2023)

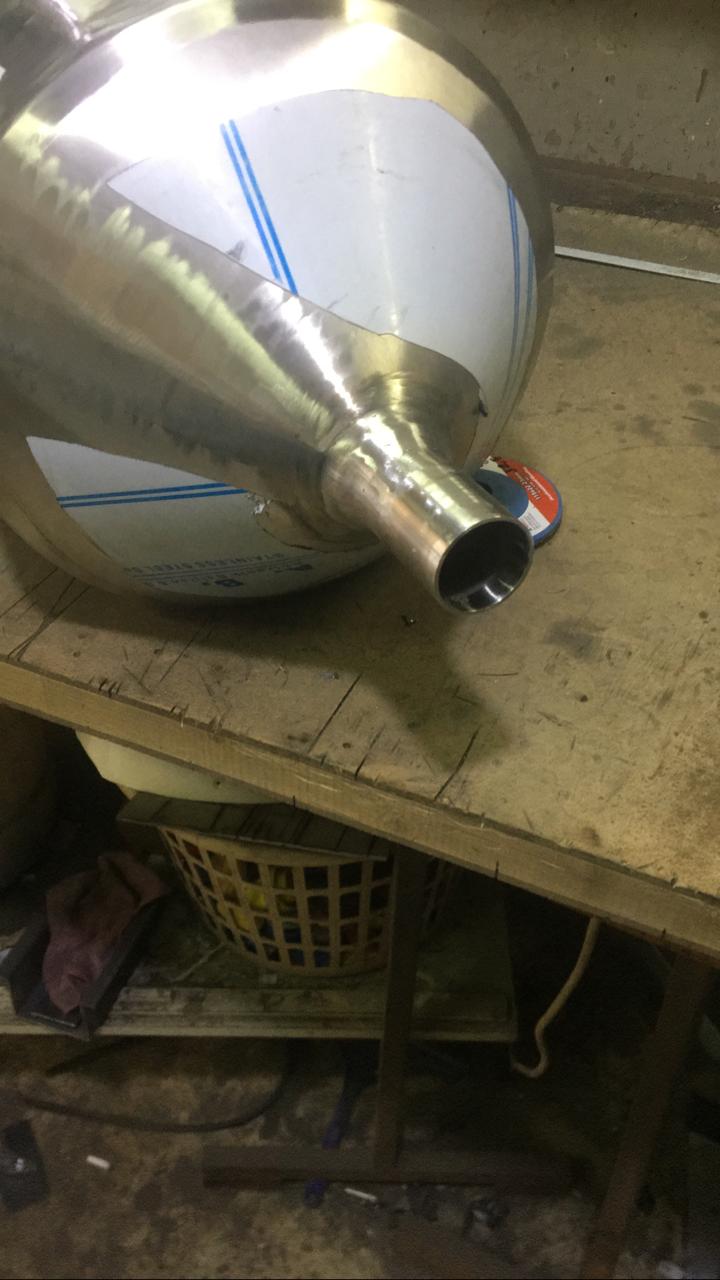

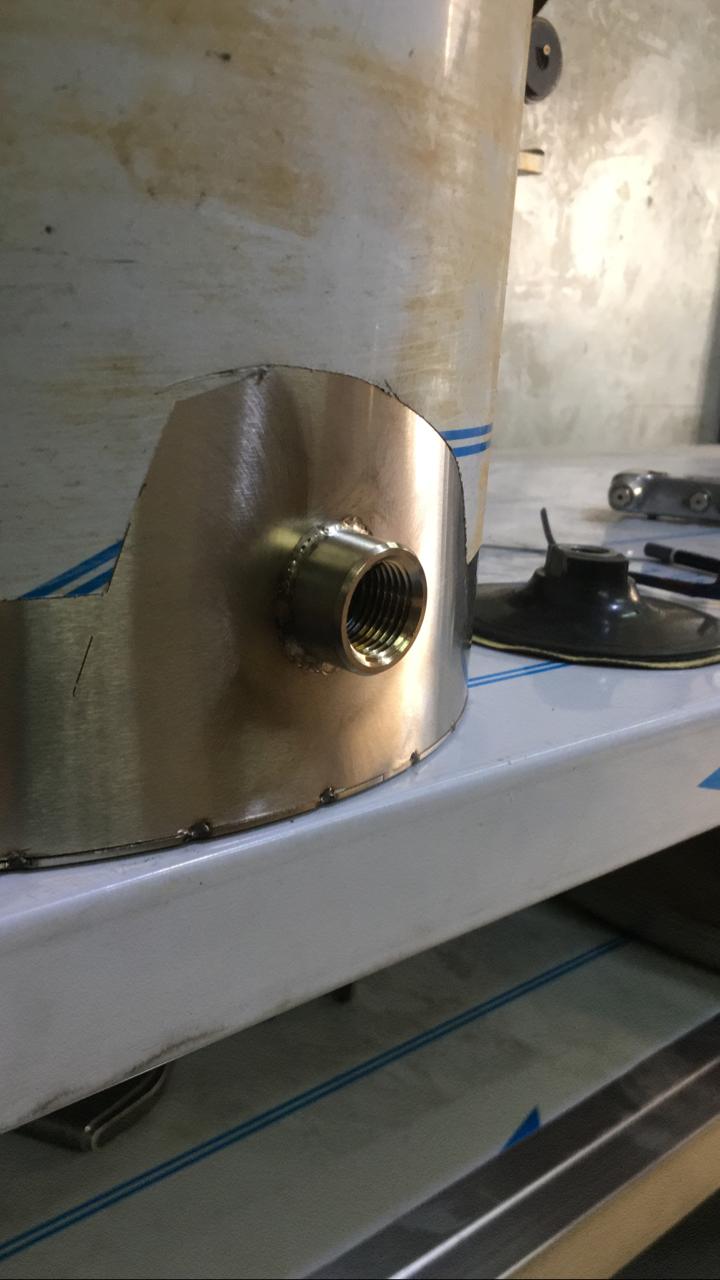

Crystallizer realisation :(21/03/2023-07/04/2023)

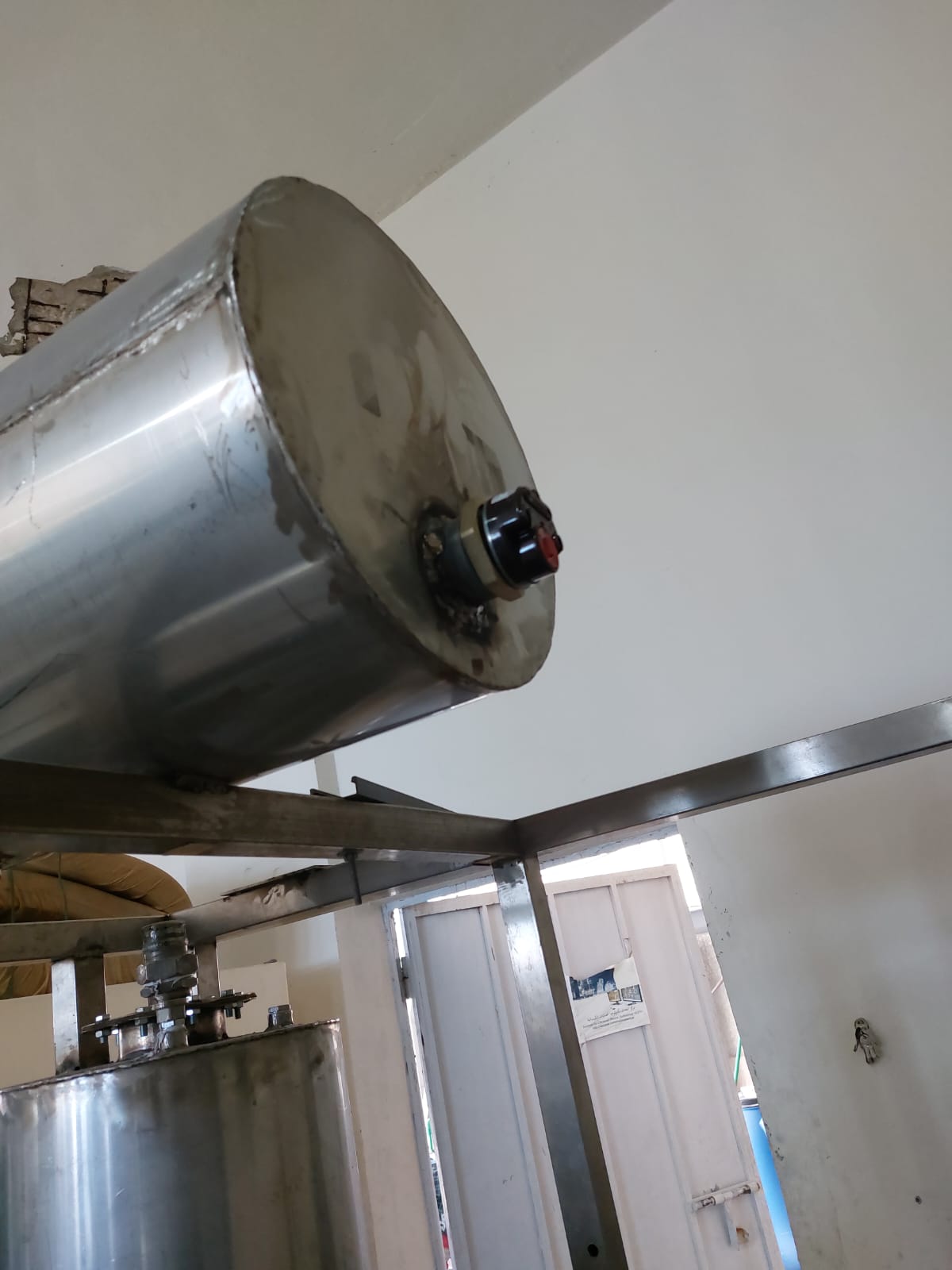

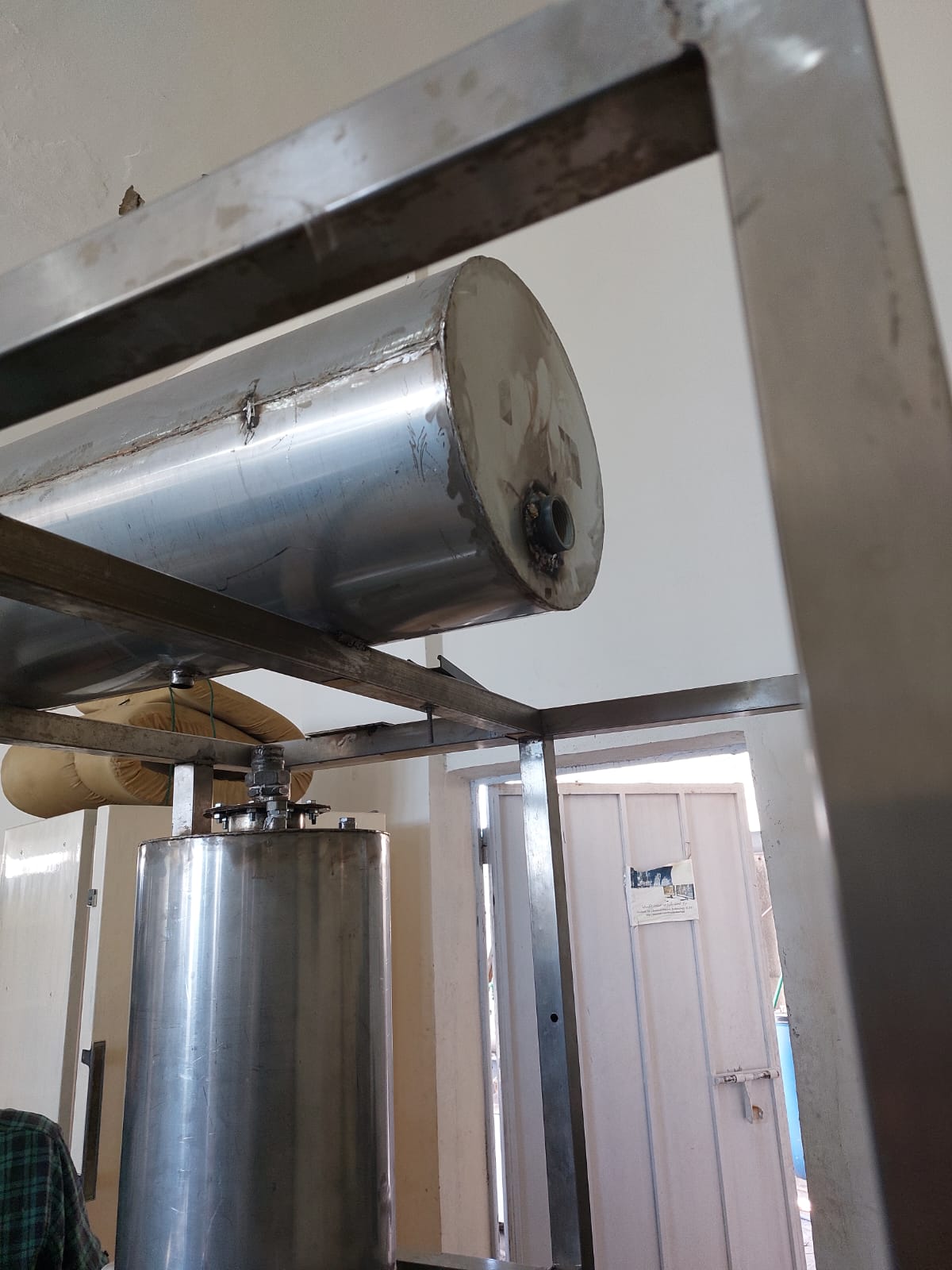

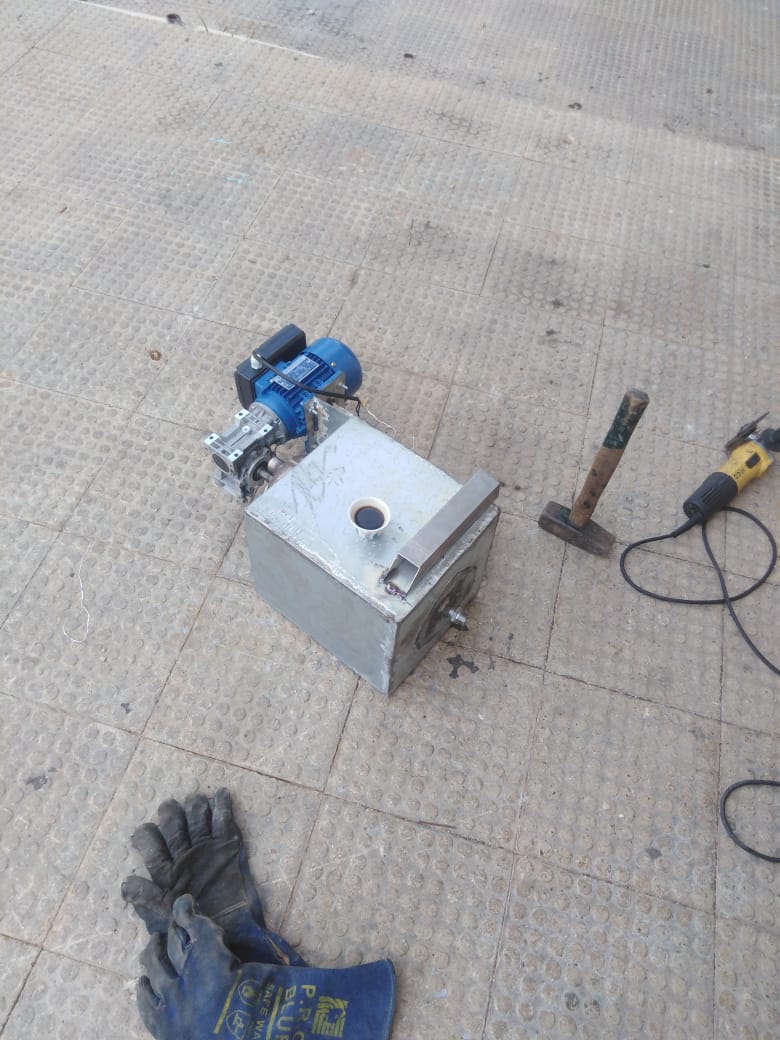

Tank 1 (The Heater) realisation:(07/04/2023)

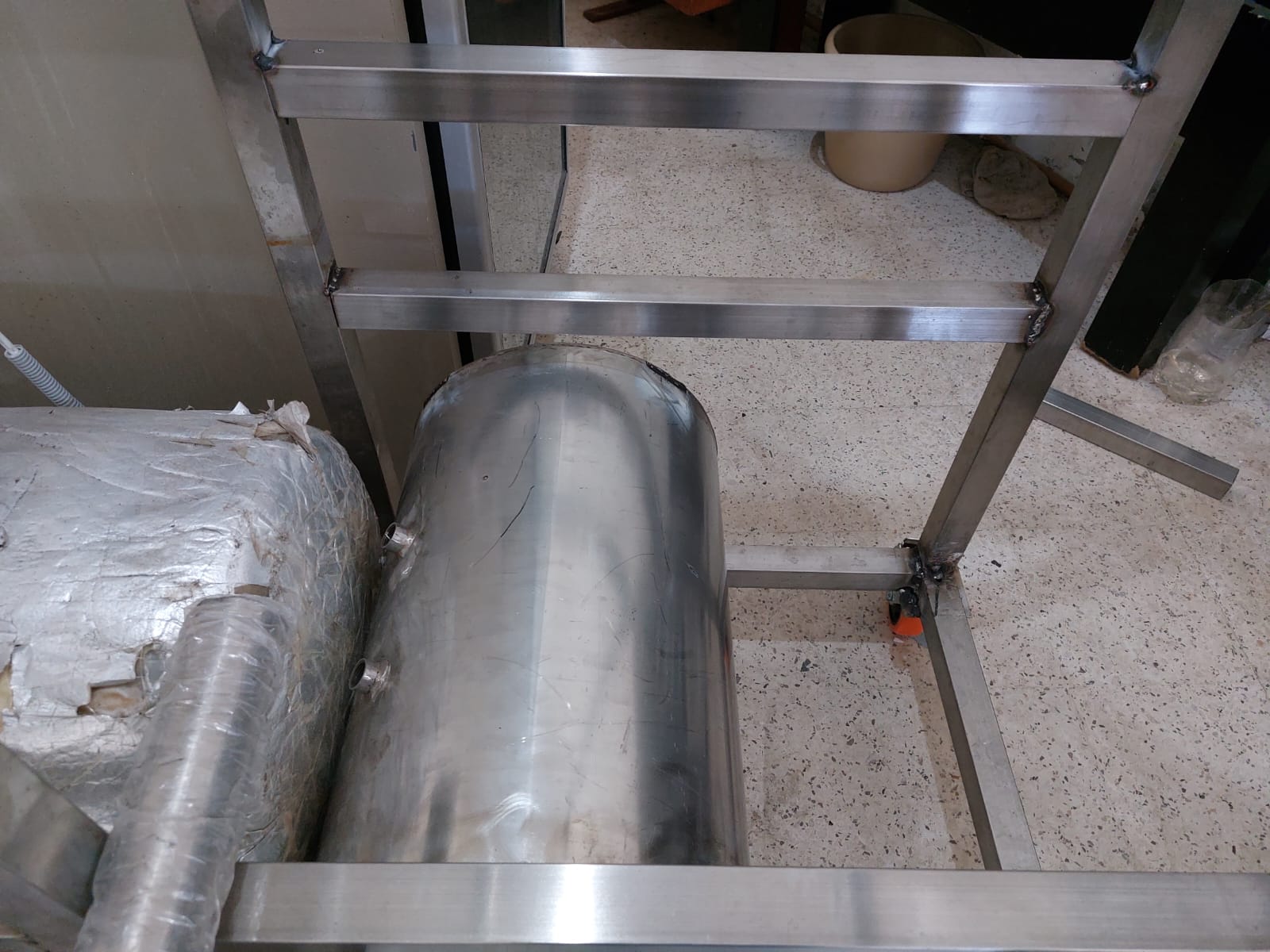

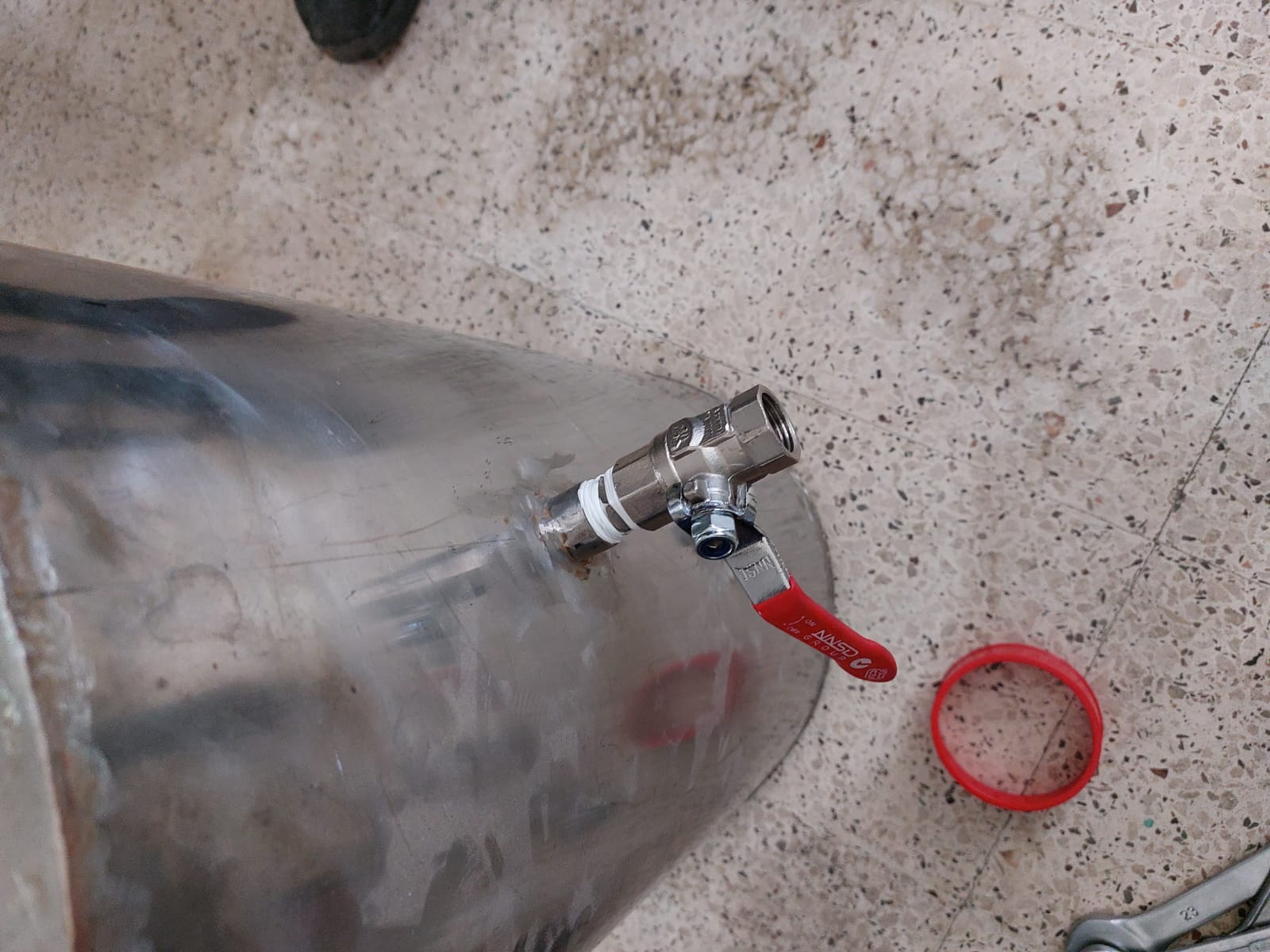

Tank 6 (Waste Tank) realisation:(07/04/2023)

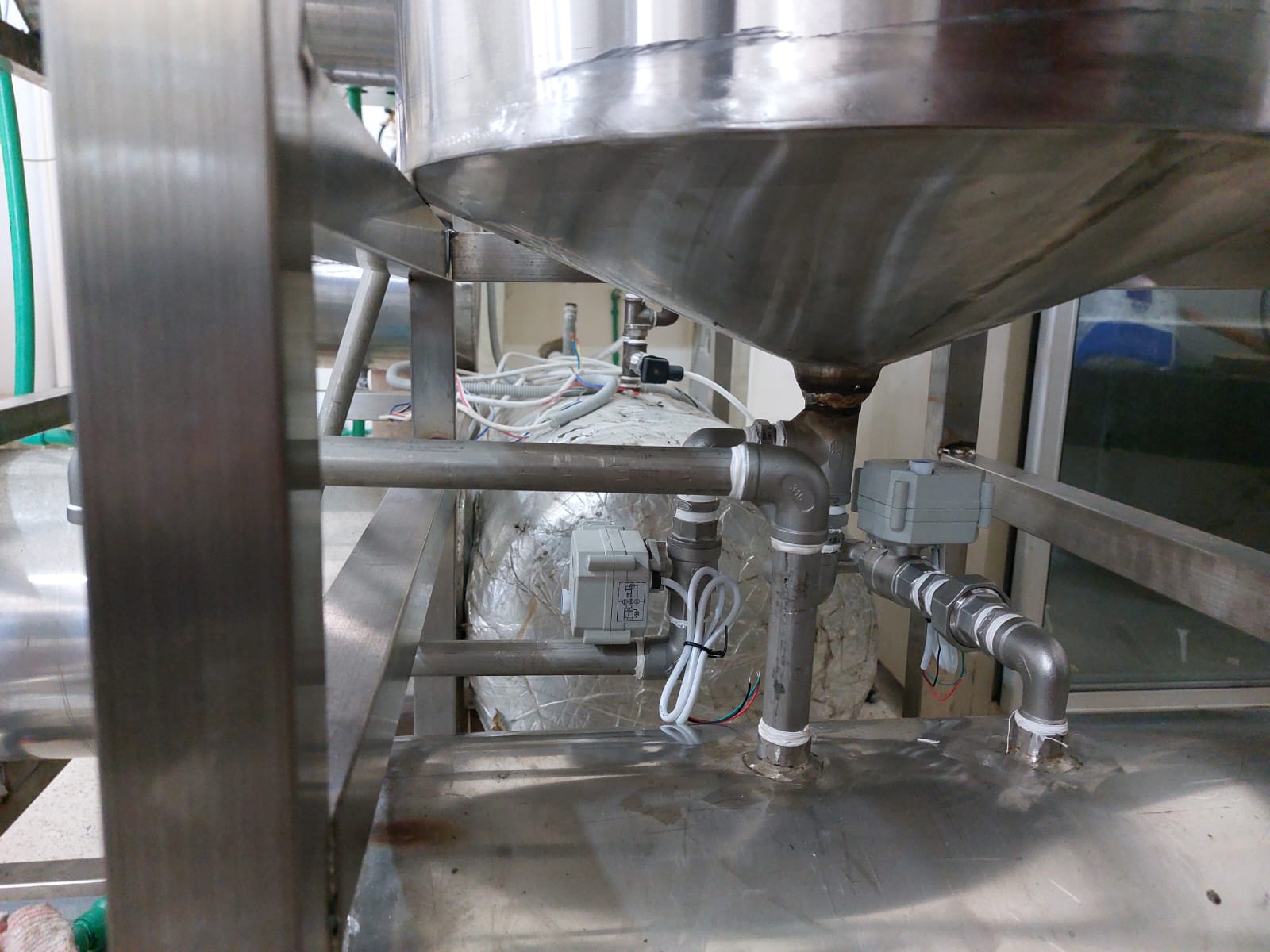

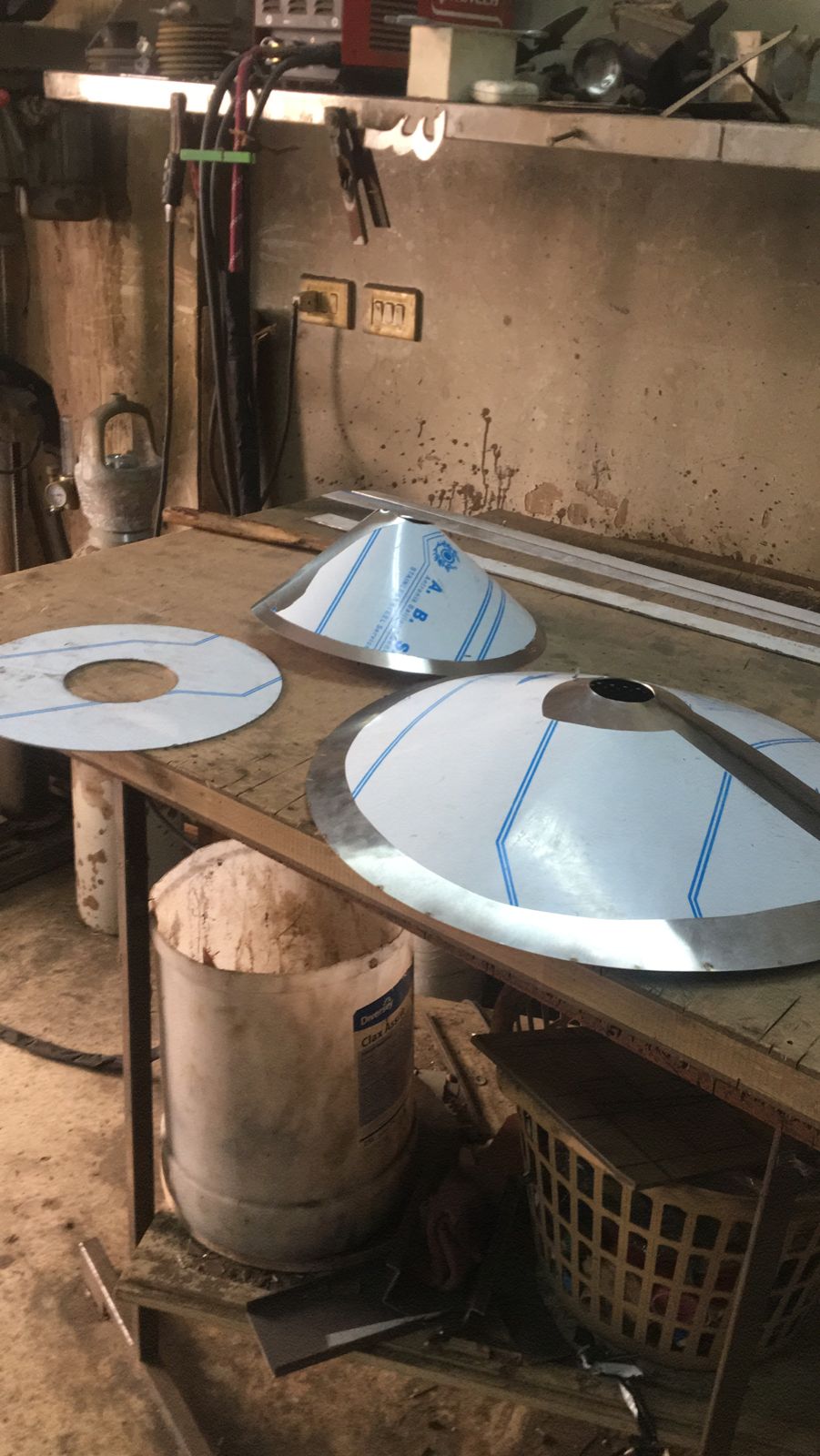

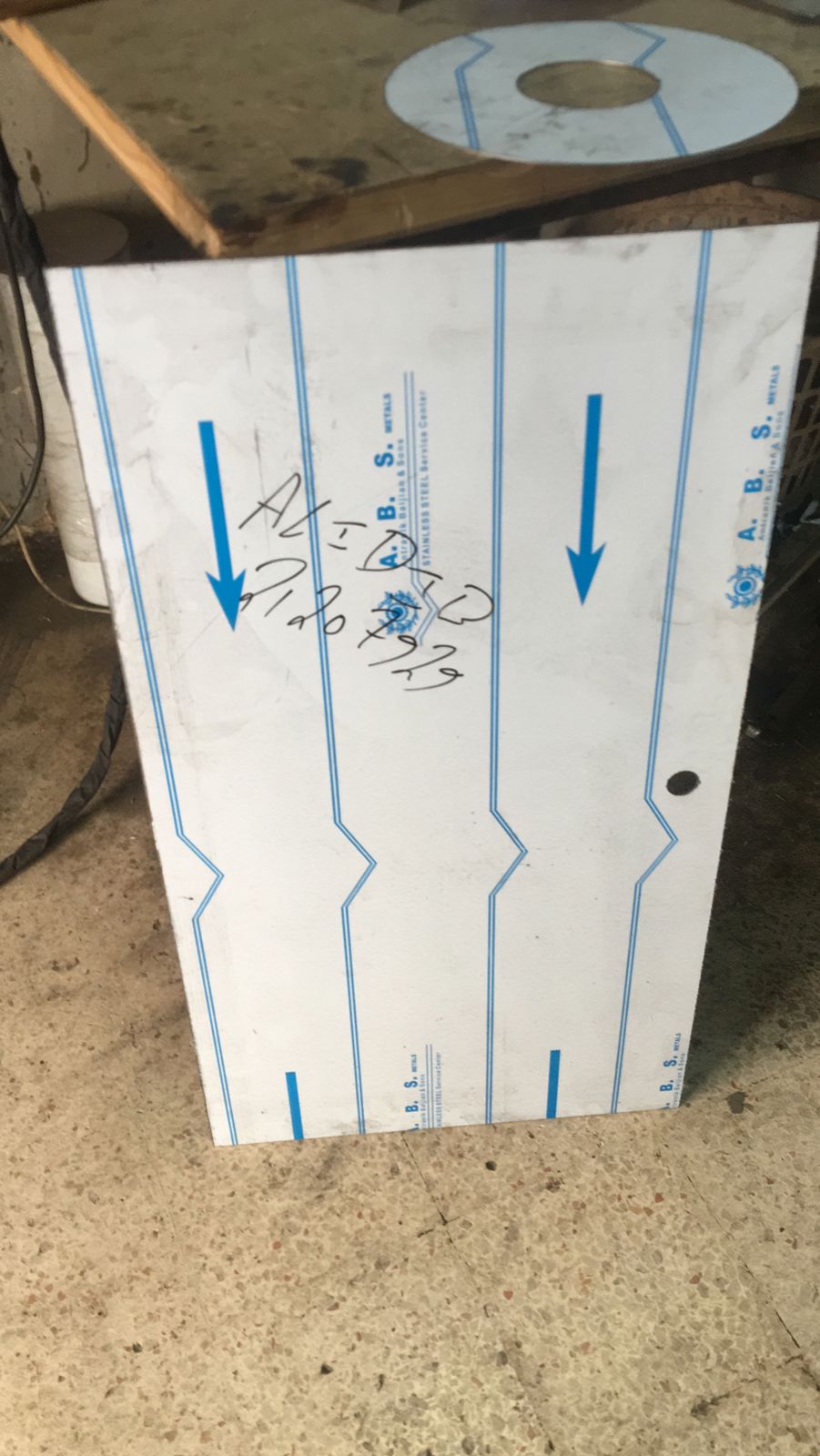

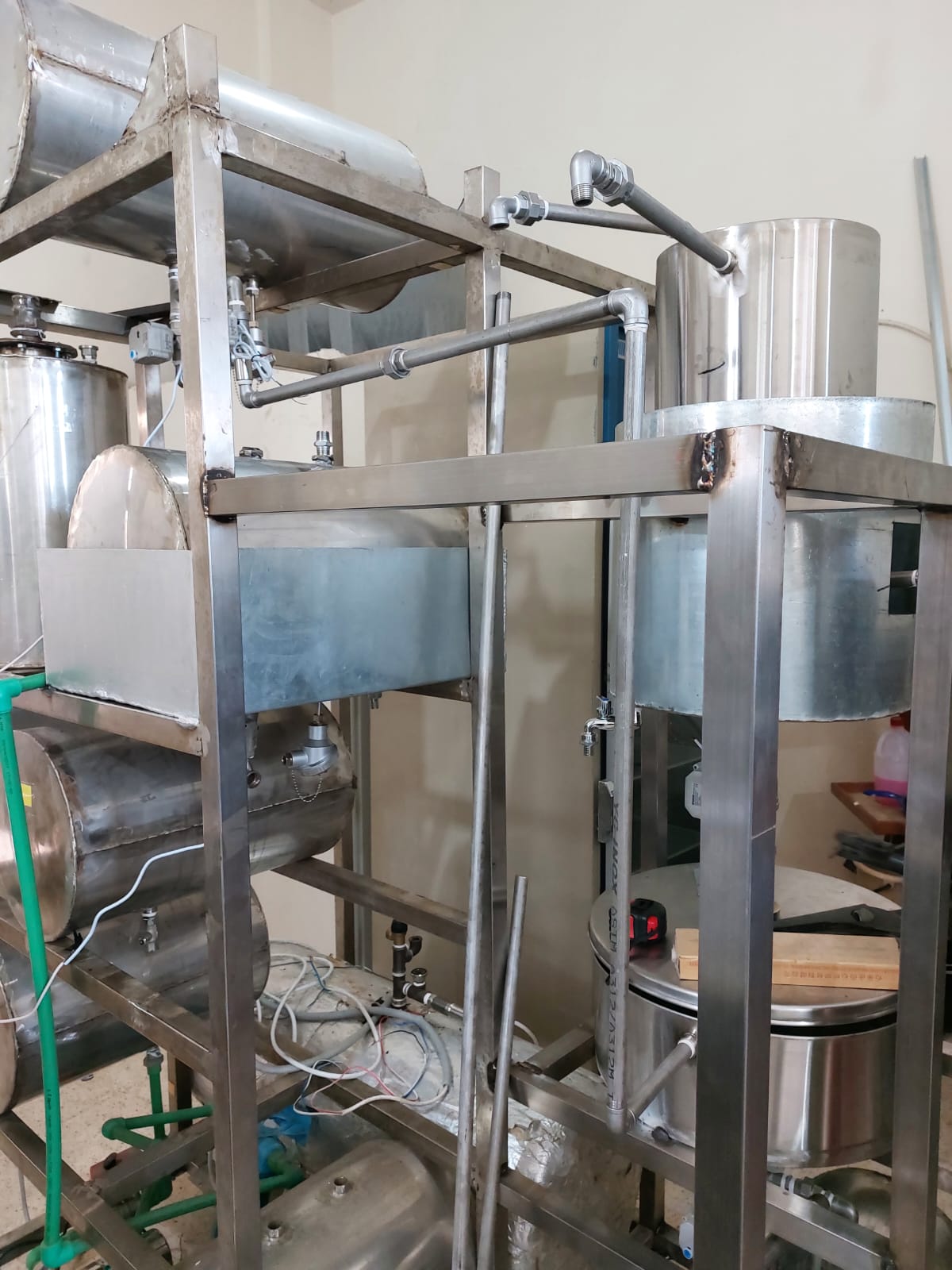

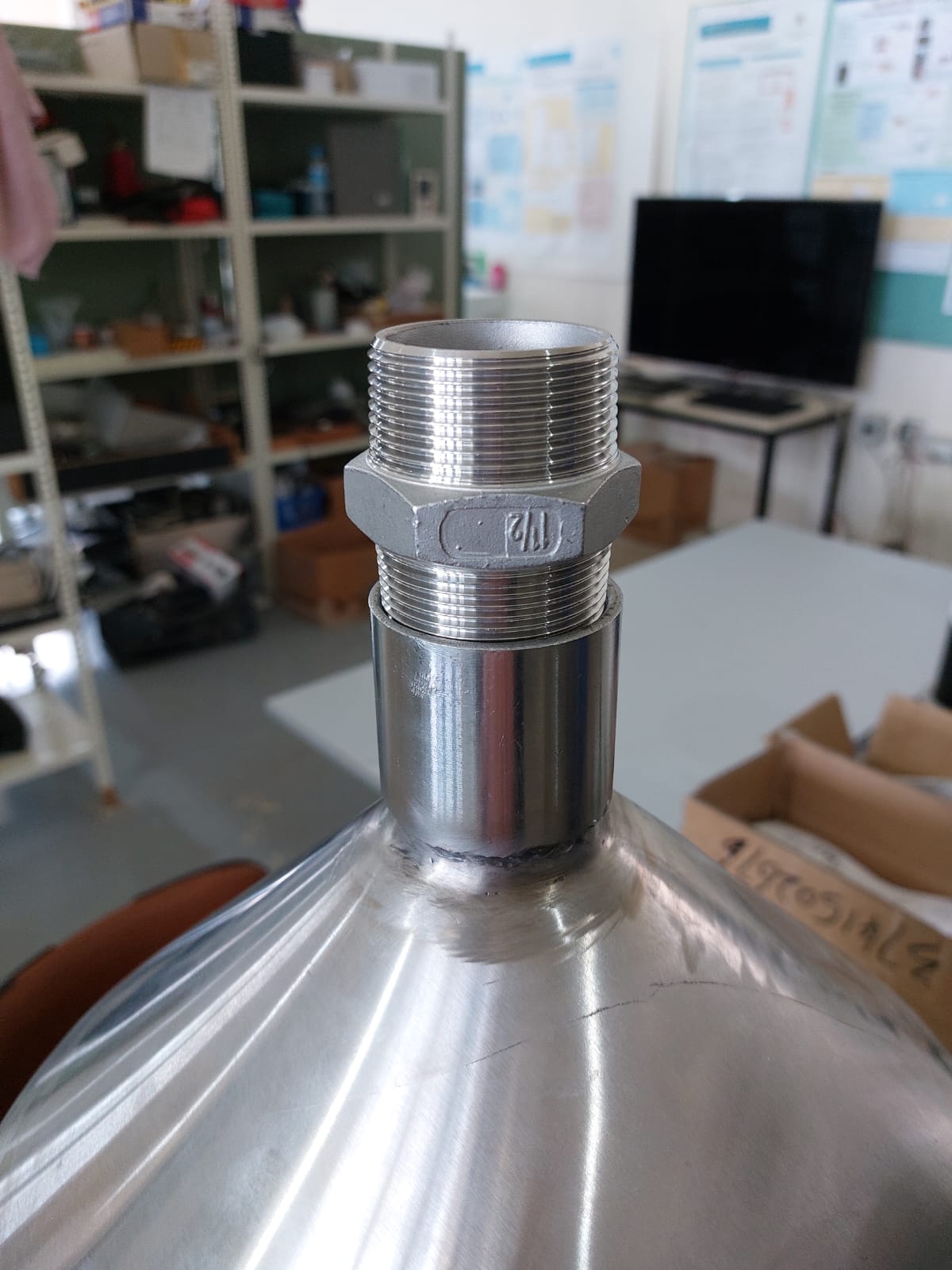

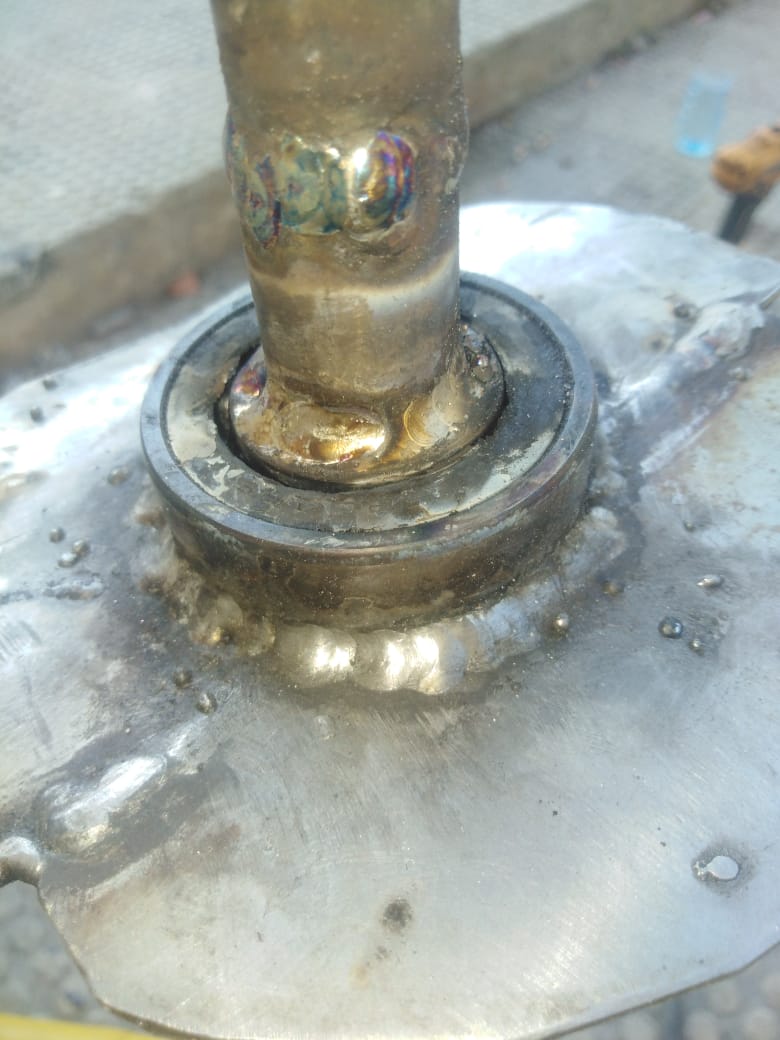

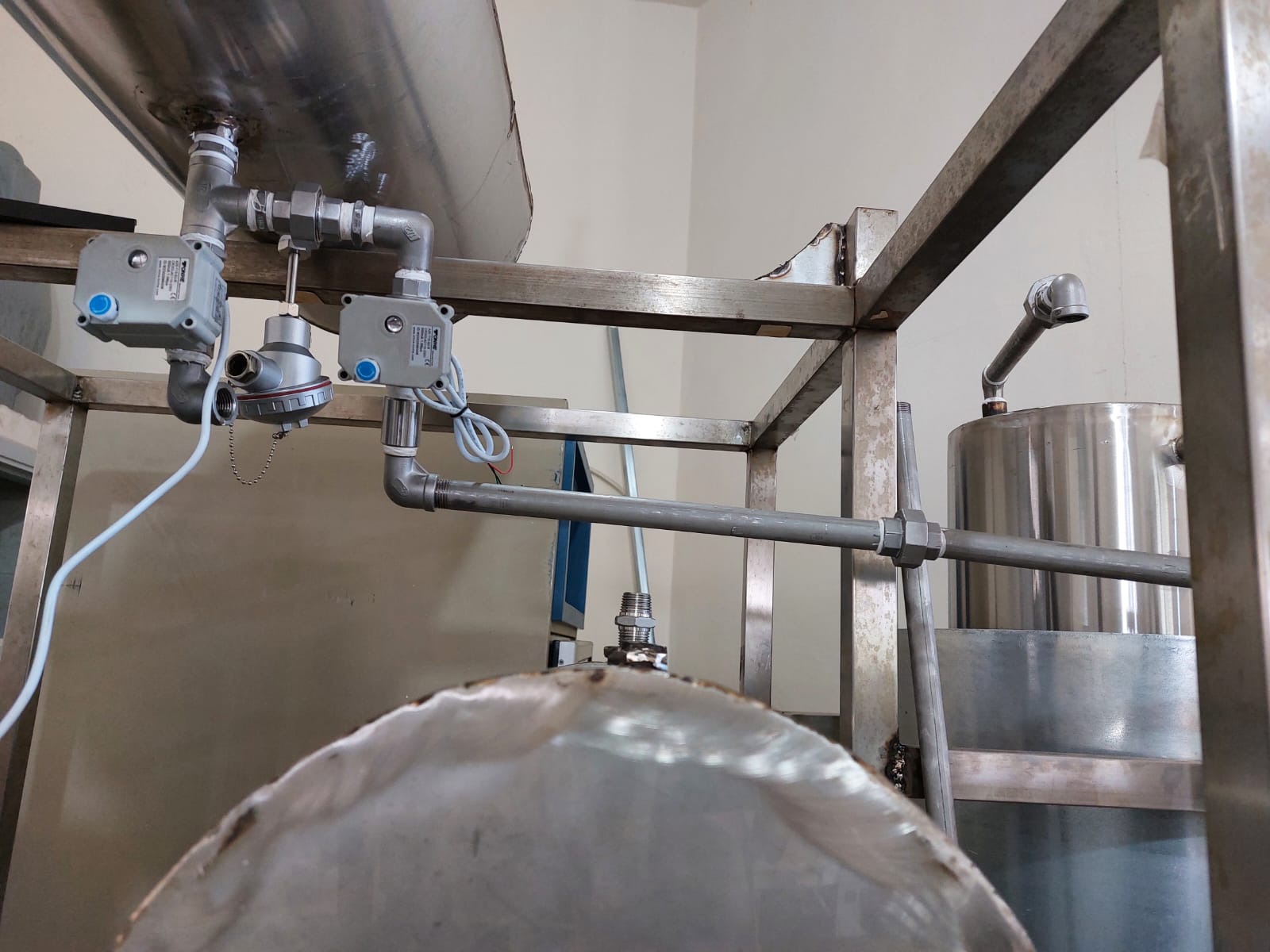

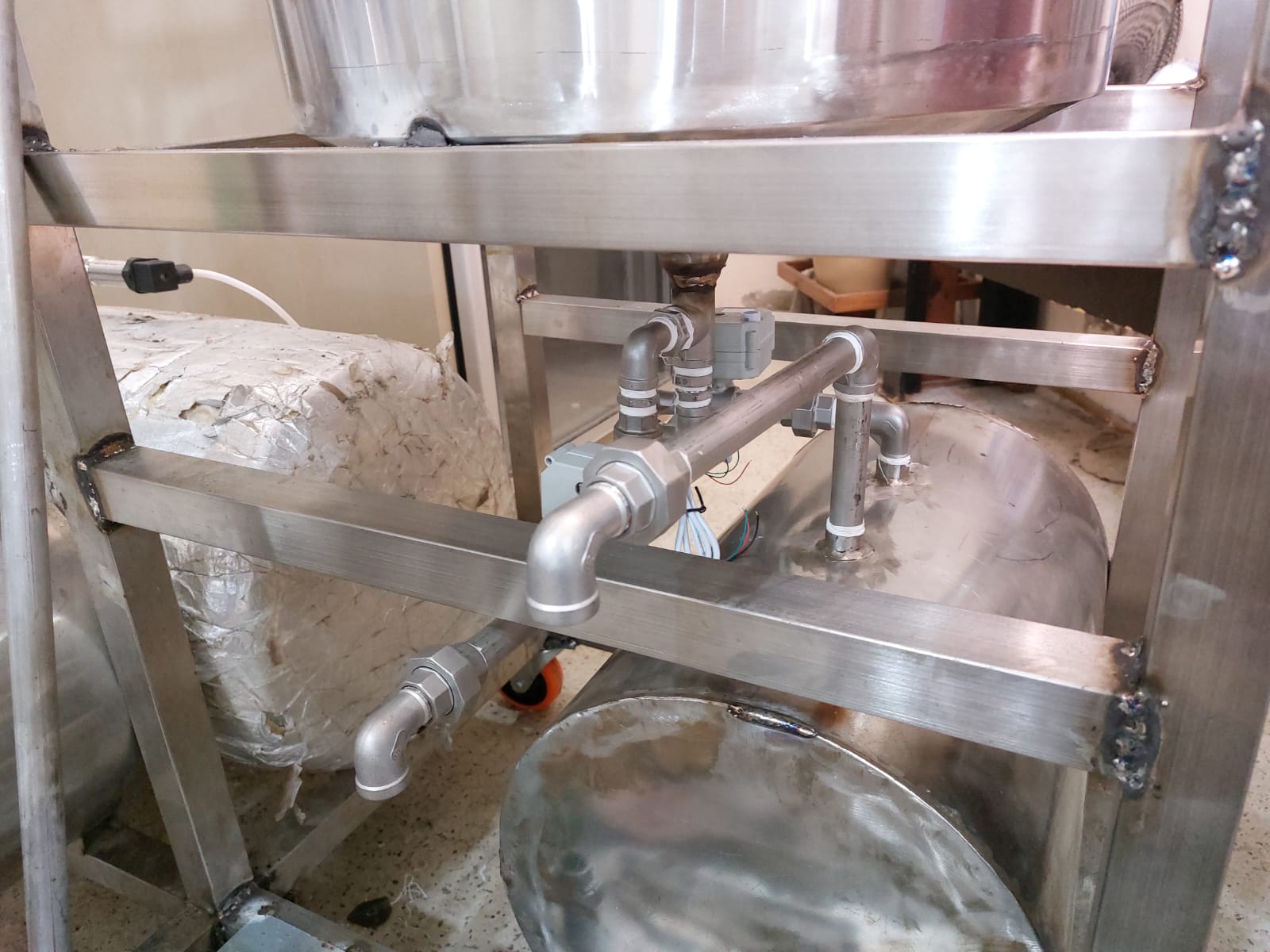

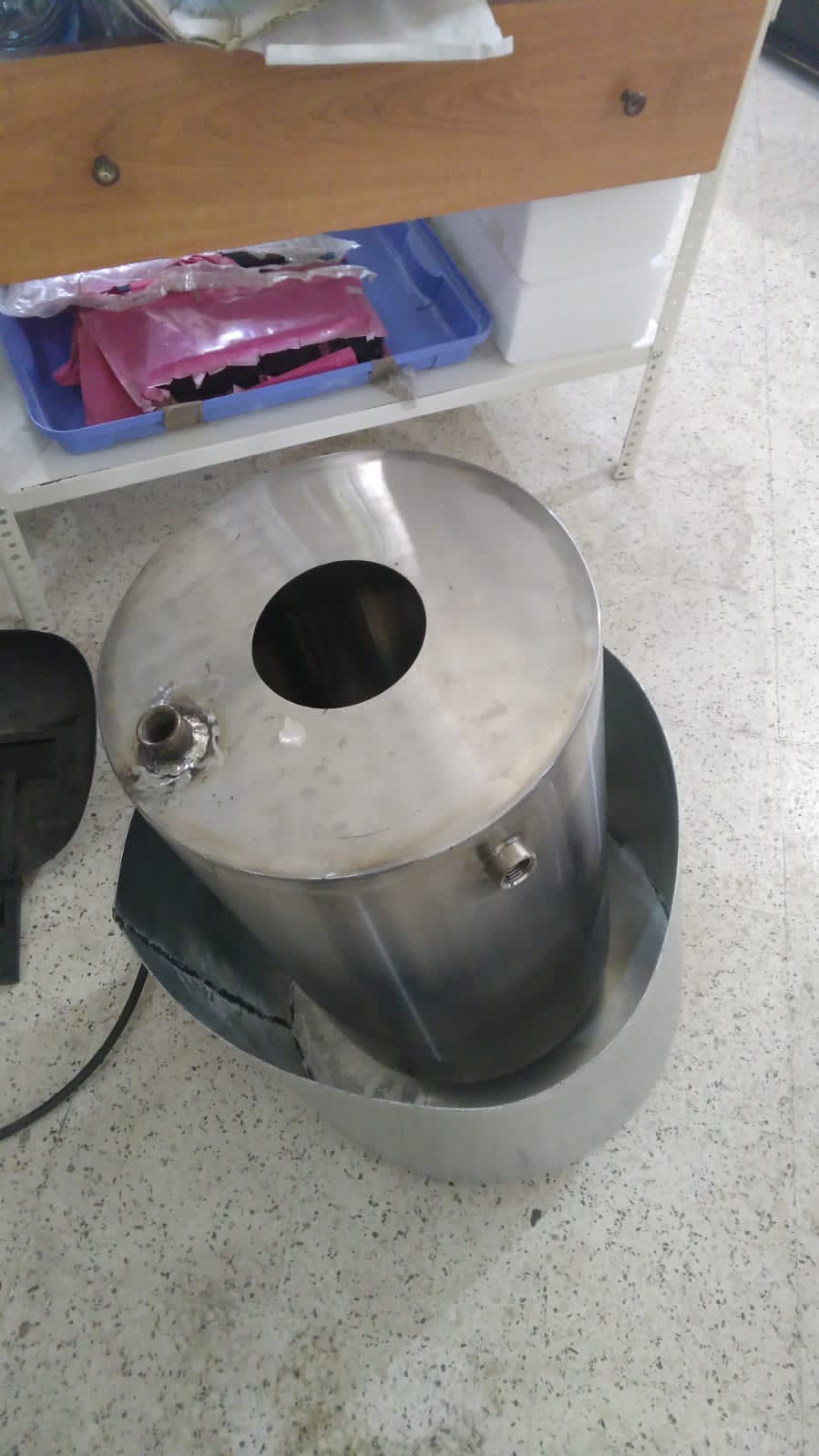

Pipes stainless steel realisation:(02/05/2023)

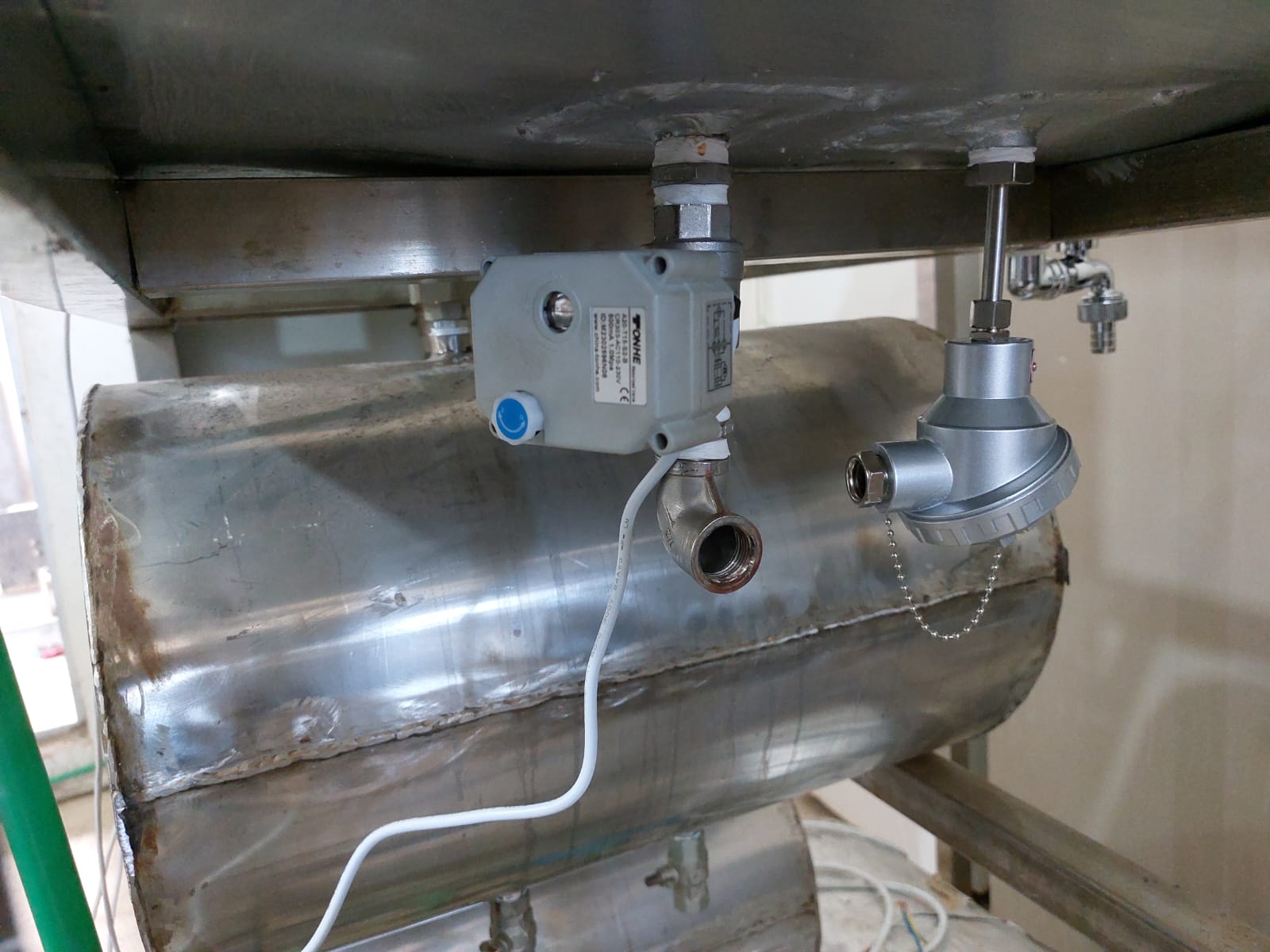

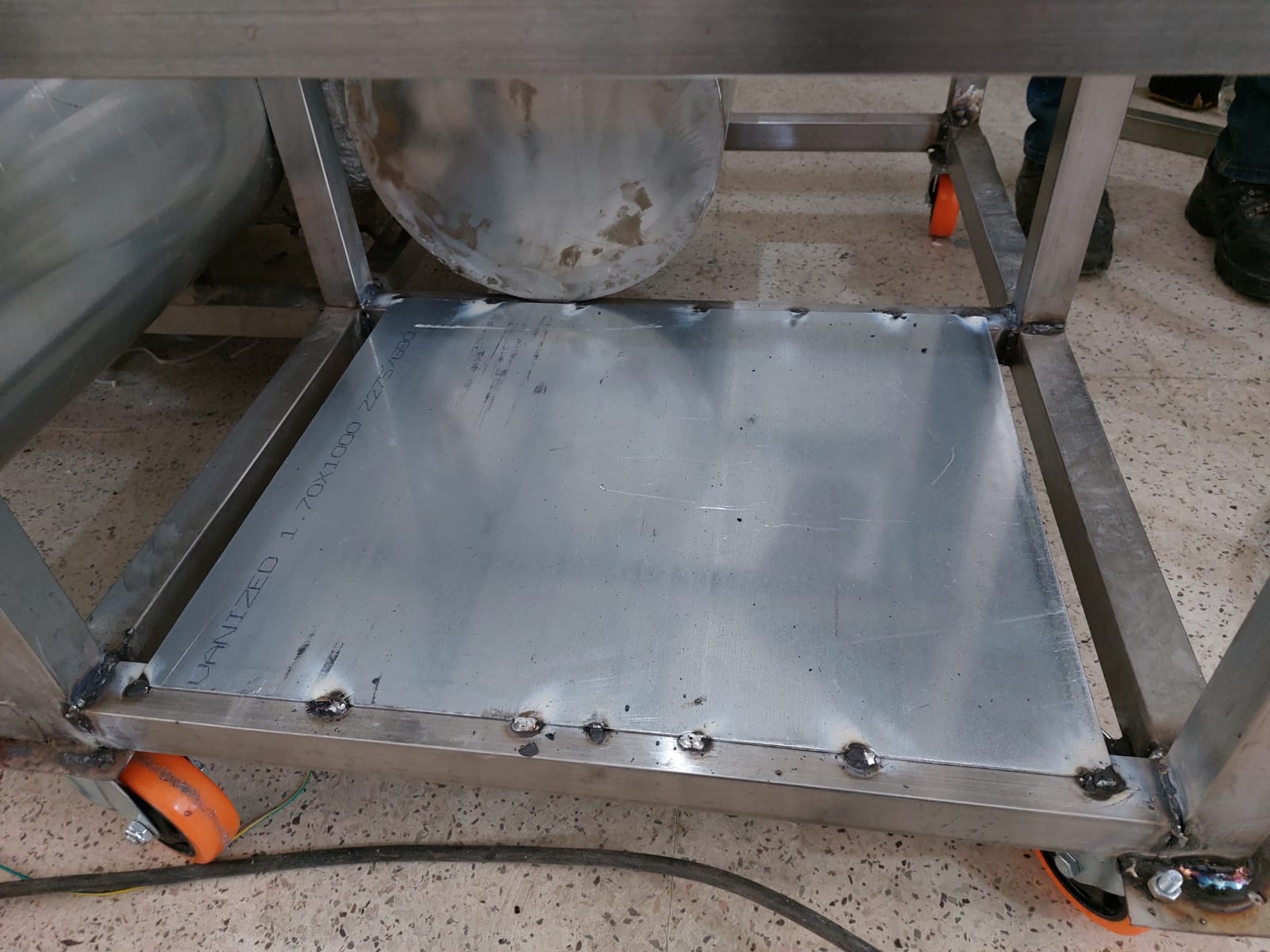

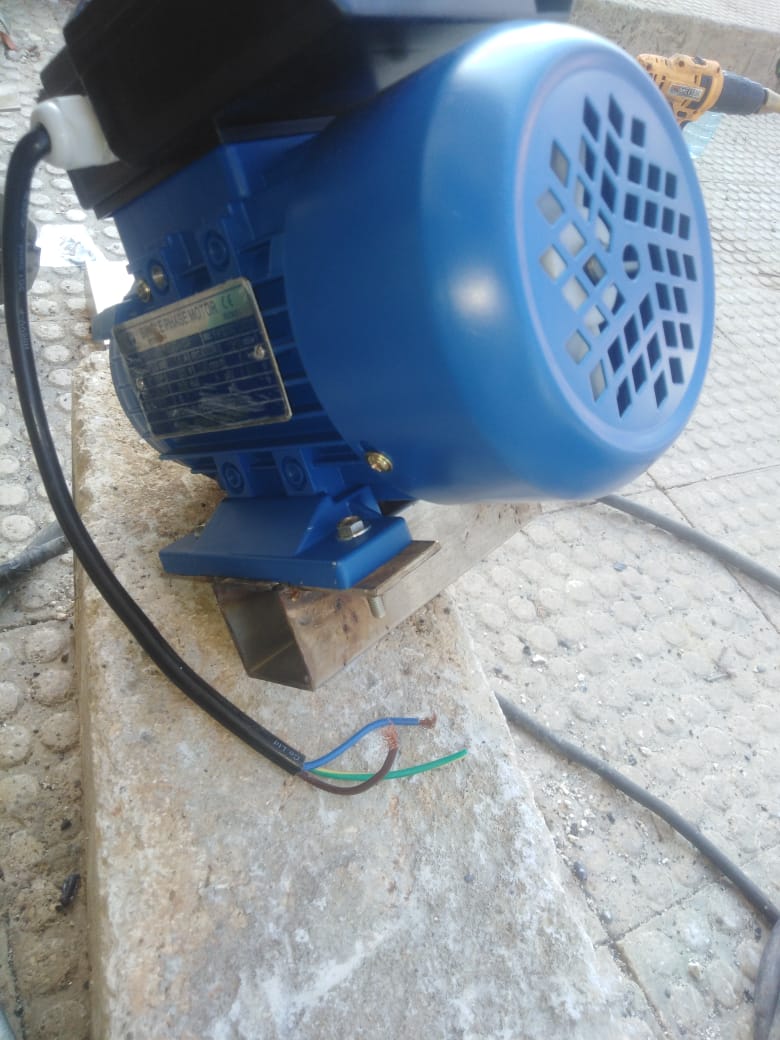

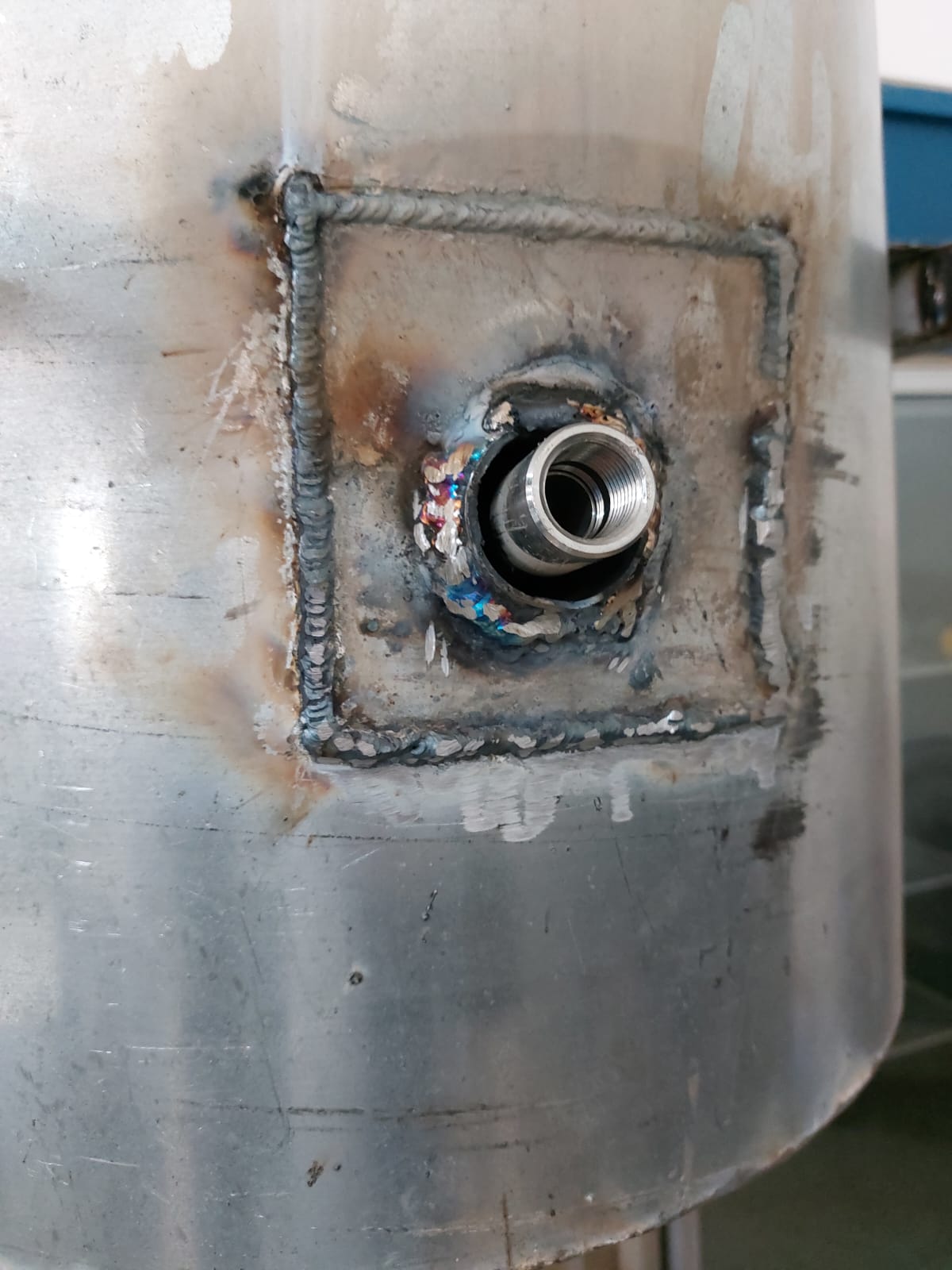

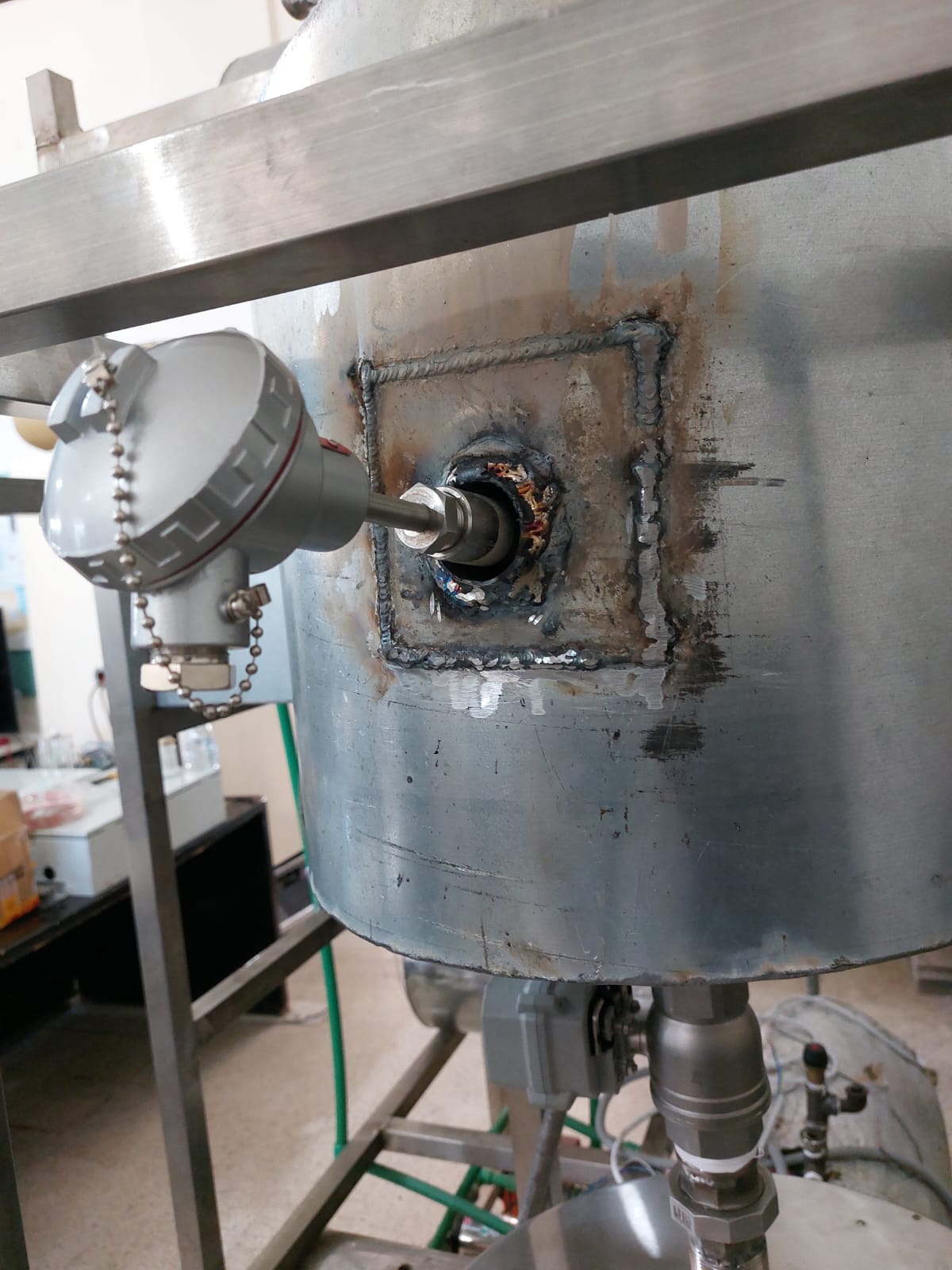

Sensors stainless steel instalation:(02/05/2023)

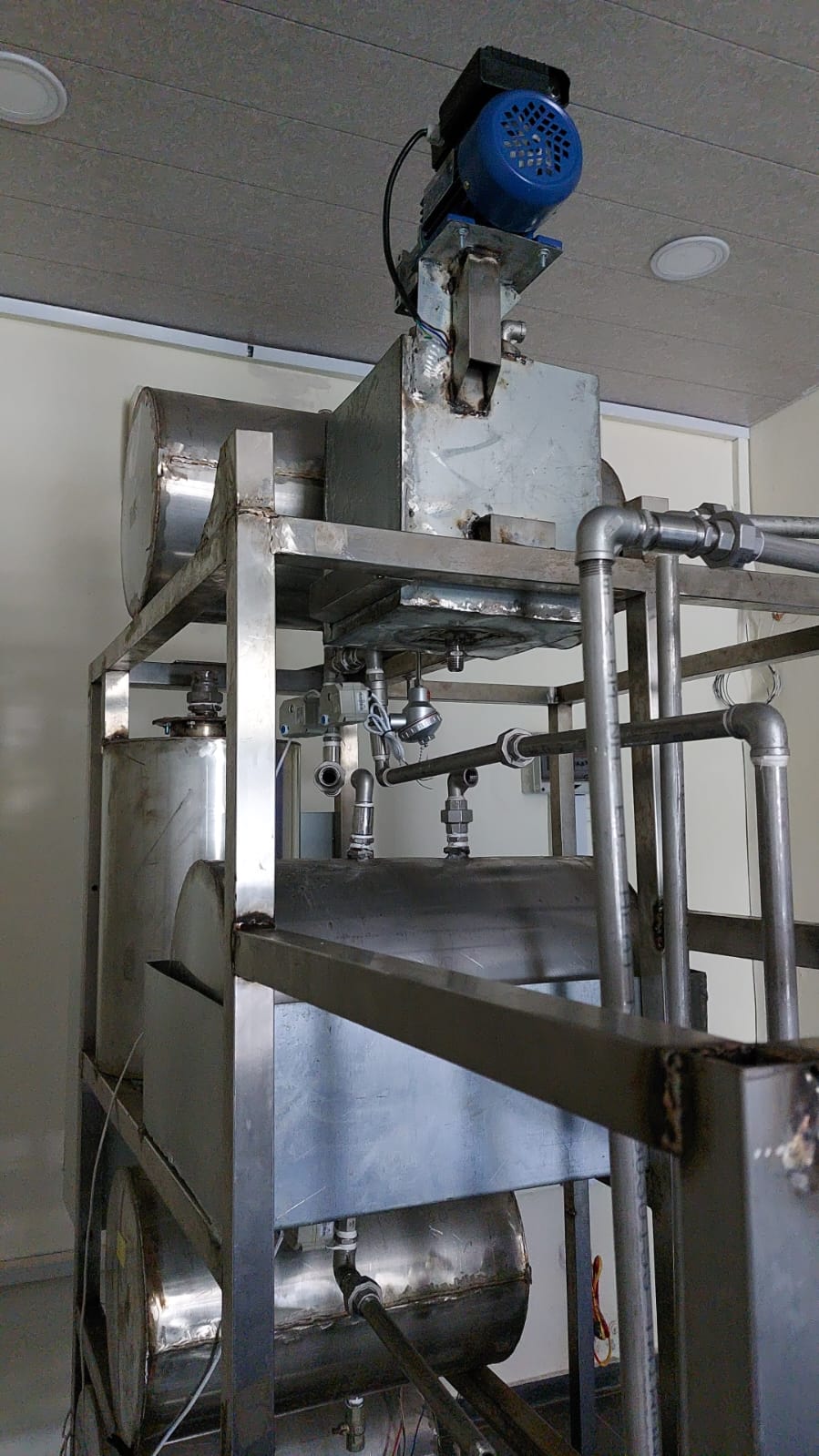

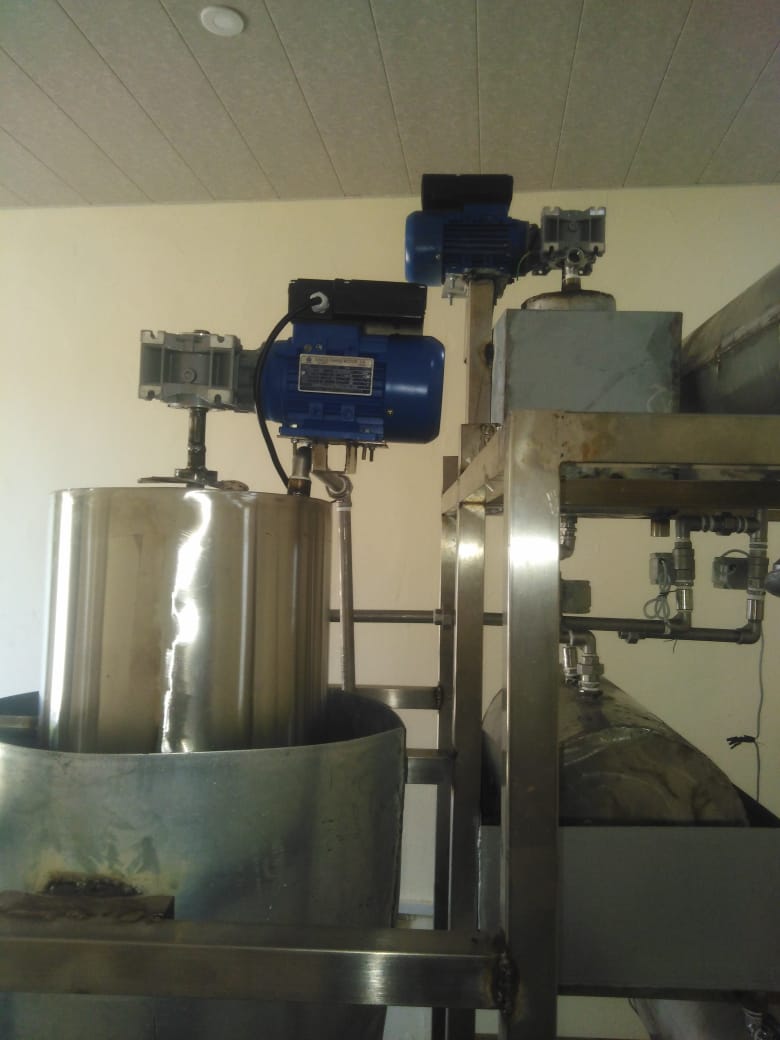

Reactor for aspirin:(20/10/2023)

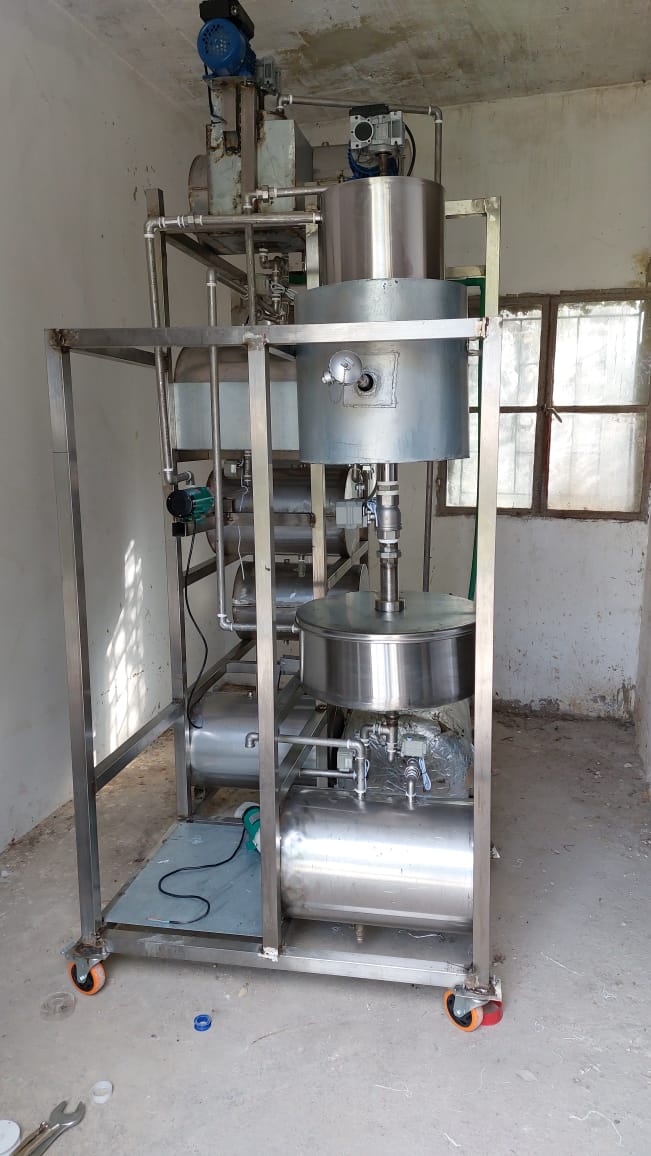

Pilot plant mechnical realization last form: (11-13-2023)
